SOMEN LIVE / BUILDOUT
the physical layer, measured from orbit
2026-10-18 05:20 UTC
GROUND TRUTH: +7.75 km2 of new built surface across 61 tracked campuses (50 moving) since their baselines.Sentinel-2 L2A (Copernicus) 10m - window-local cloud gate - method badge P pixel / L llm-draft / H human-counted - * = confirmed

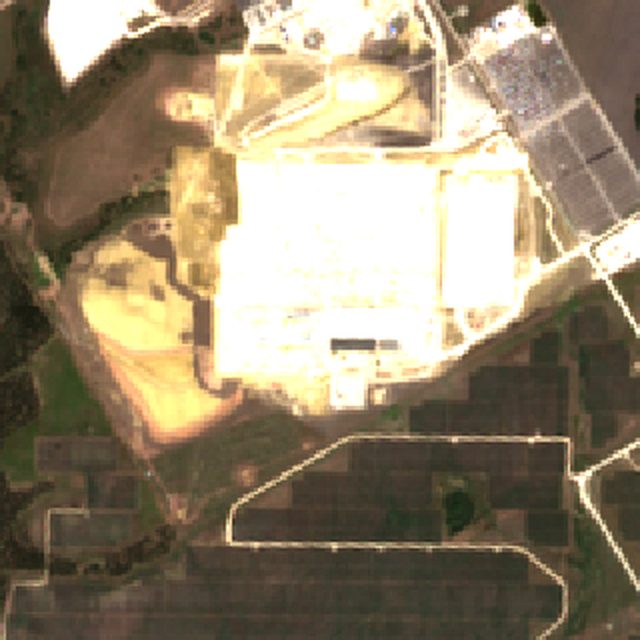

epoch_openai_stargate_milam

openai with microsoft, oracle - 4.0 km2 window - Epoch map building polygons (n=9 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-270.1%0.00 km2P
2026-10-0715.7%0.63 km2P

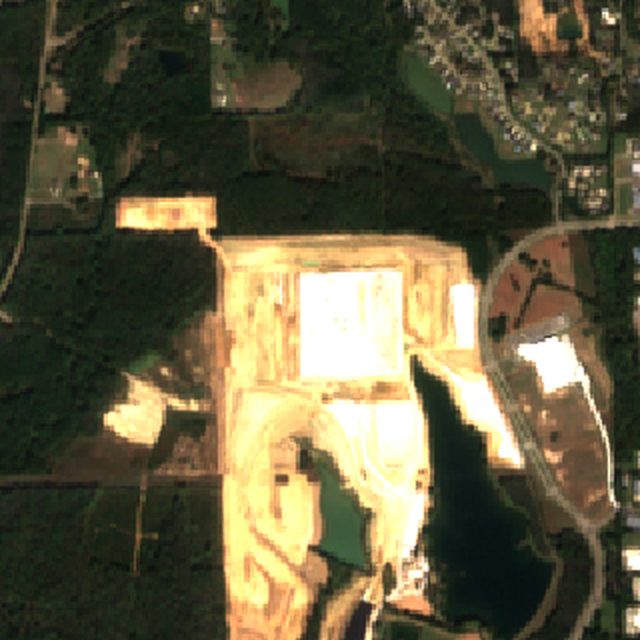

epoch_amazon_ridgeland

amazon with anthropic - 4.6 km2 window - Epoch map building polygons (n=94 vertices)
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-16
SCENEBUILTAREAMETHOD
2024-10-264.2%0.19 km2P*
2026-10-1617.6%0.81 km2P*

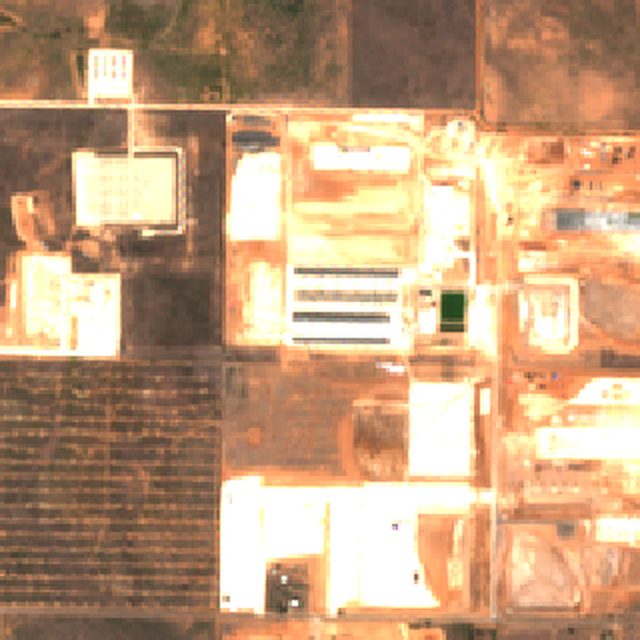

epoch_coreweave_helios

coreweave - 4.0 km2 window - Epoch map building polygons (n=37 vertices)
latest scenebaseline scene
baseline 2024-10-23latest 2026-10-08
SCENEBUILTAREAMETHOD
2024-10-230.8%0.03 km2P*
2026-10-0812.4%0.50 km2P*

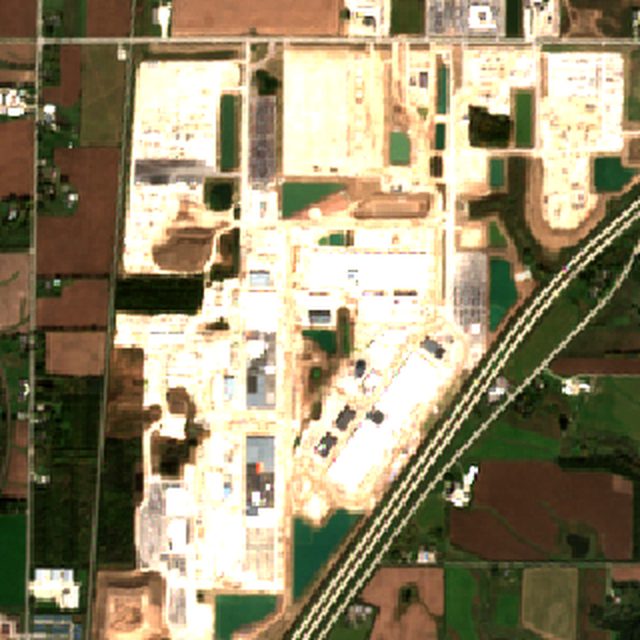

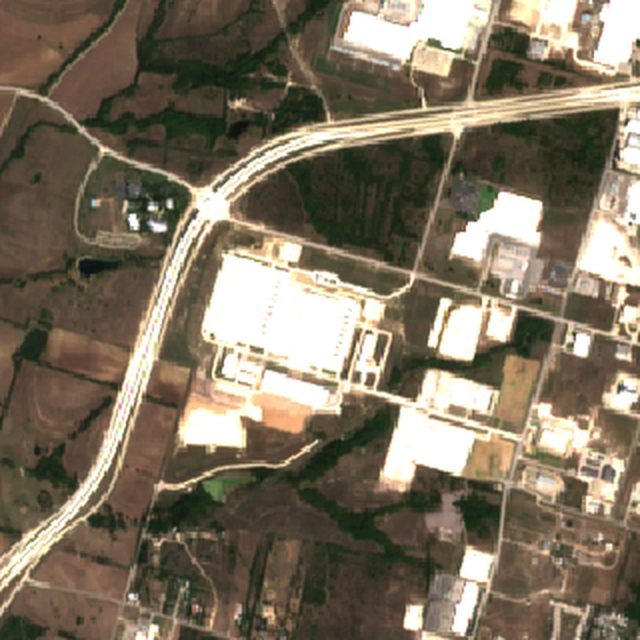

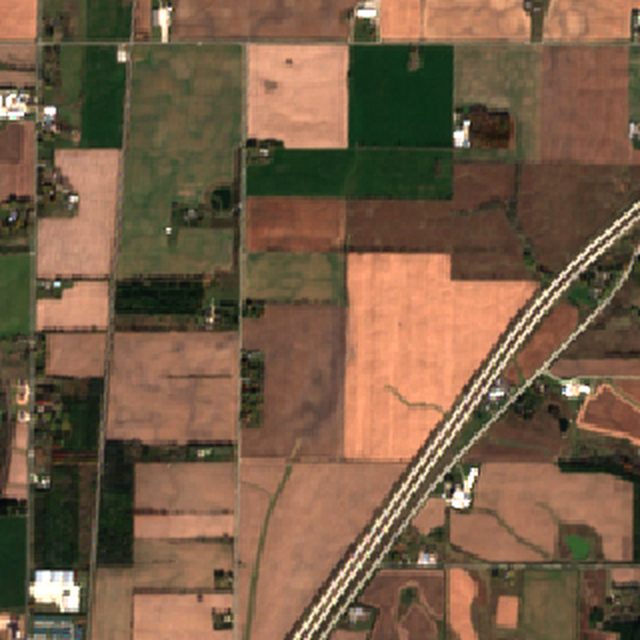

epoch_openai_stargate_wisconsin

openai with microsoft, oracle - 6.0 km2 window - Epoch map building polygons (n=18 vertices)
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-260.9%0.05 km2P*
2026-10-1312.1%0.72 km2P*

epoch_nebius_mantsala

nebius - 4.8 km2 window - Epoch map building polygons (n=37 vertices)
latest scenebaseline scene
baseline 2024-10-30latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-309.5%0.46 km2P*
2026-10-1319.5%0.94 km2P*

epoch_openai_stargate_uae

openai with microsoft, oracle - 4.0 km2 window - Epoch map building polygons (n=25 vertices)
latest scenebaseline scene
baseline 2024-10-29latest 2026-10-14
SCENEBUILTAREAMETHOD
2024-10-2976.3%3.05 km2P*
2026-10-1466.4%2.66 km2P*

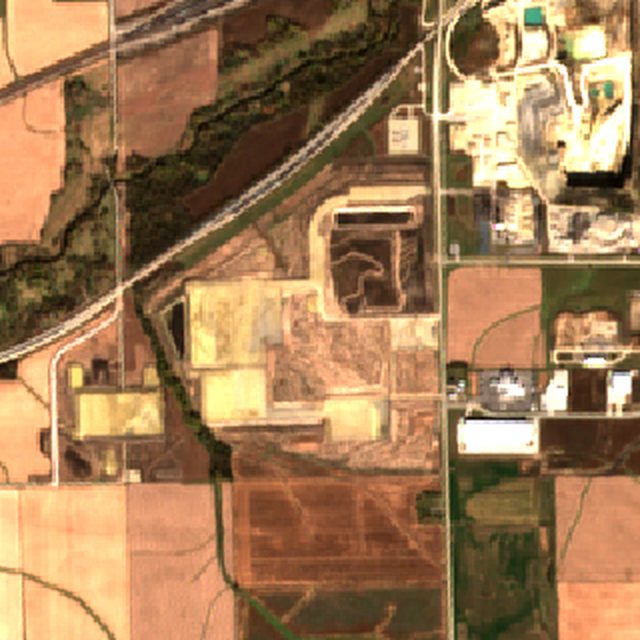

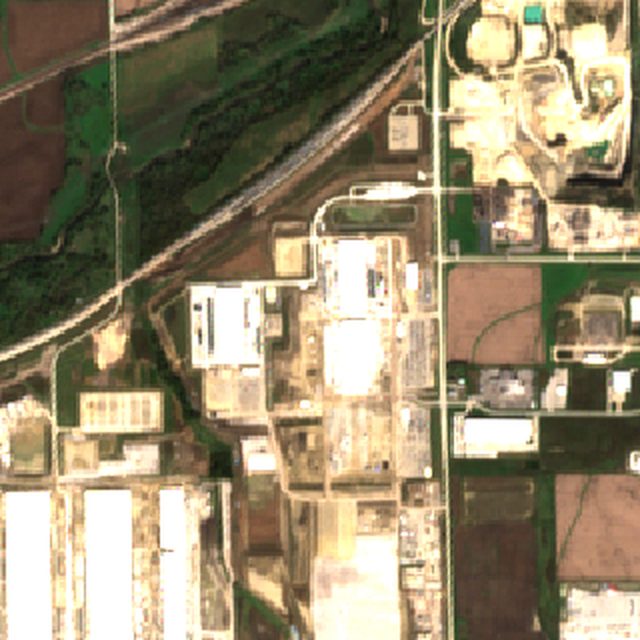

epoch_google_cedar_rapids

google - 5.7 km2 window - Epoch map building polygons (n=68 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-271.6%0.09 km2P*
2026-10-129.5%0.54 km2P*

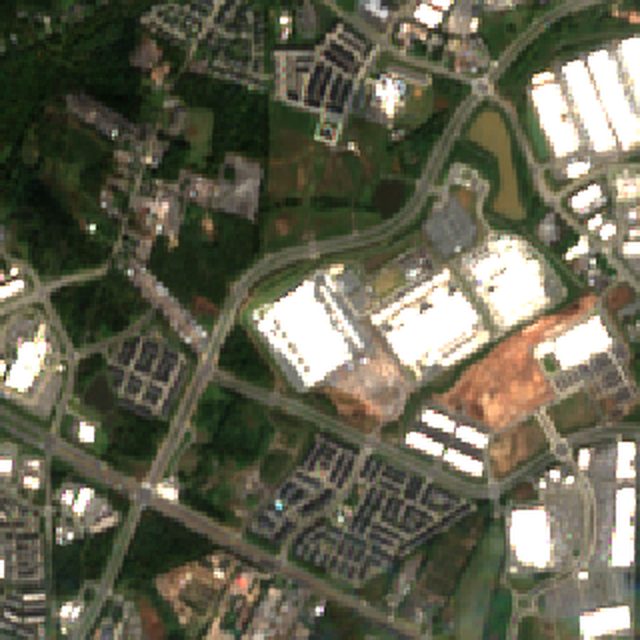

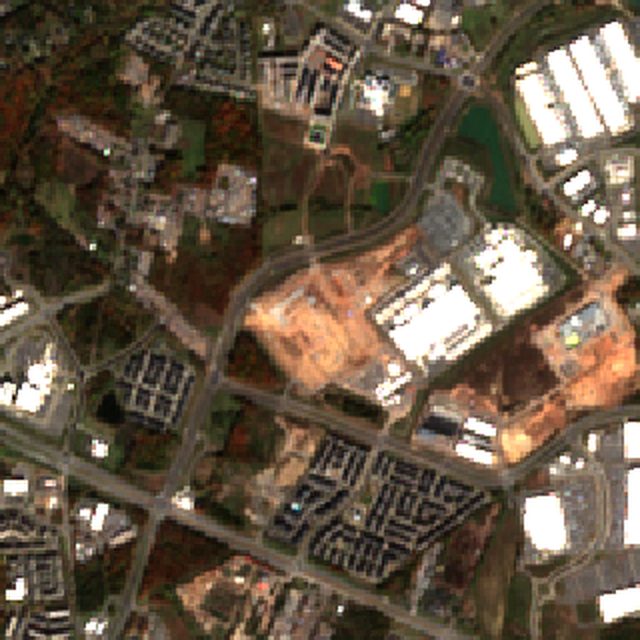

epoch_google_arcola

google - 4.0 km2 window - Epoch map building polygons (n=29 vertices)
latest scenebaseline scene
baseline 2024-10-31latest 2026-10-14
SCENEBUILTAREAMETHOD
2024-10-318.8%0.35 km2P*
2026-10-1415.8%0.63 km2P*

epoch_google_red_oak

google - 4.2 km2 window - Epoch map building polygons (n=45 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-273.4%0.14 km2P*
2026-10-159.1%0.39 km2P*

epoch_meta_temple

meta - 7.0 km2 window - Epoch map building polygons (n=48 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-2716.7%1.16 km2P*
2026-10-1511.3%0.79 km2P*

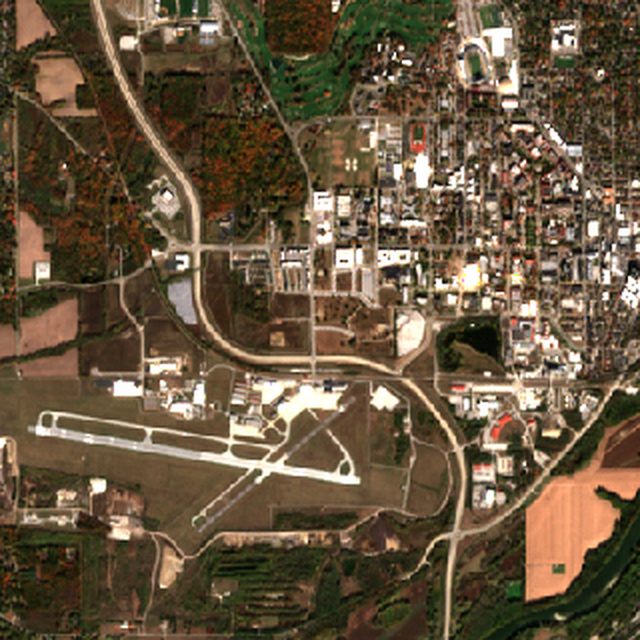

sk_hynix_west_lafayette

sk_hynix - 16.0 km2 window - APPROX West Lafayette IN -- pin from Purdue/site docs
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-263.1%0.50 km2P*
2026-10-138.1%1.30 km2P*

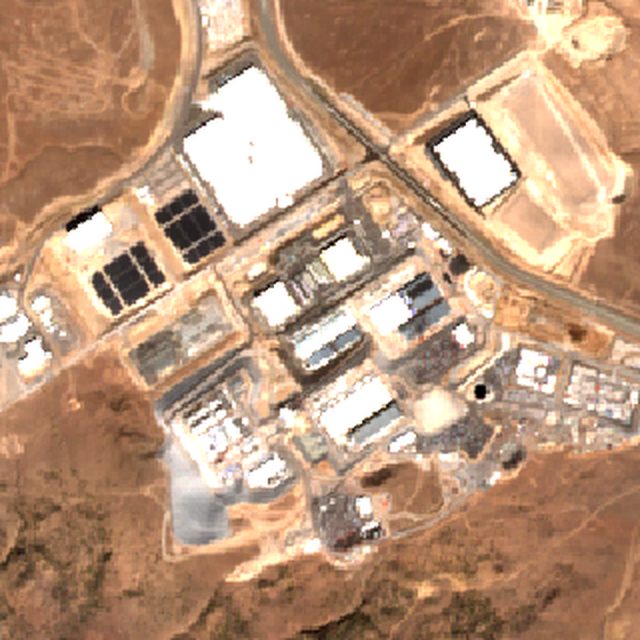

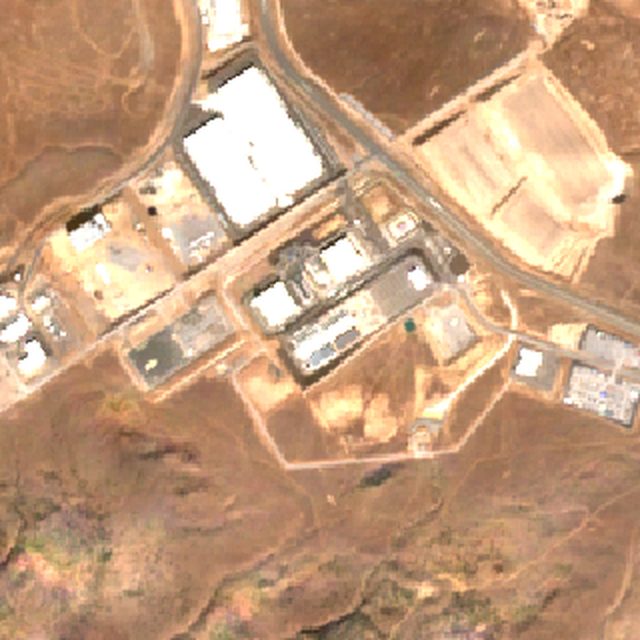

epoch_google_storey_county

google - 5.6 km2 window - Epoch map building polygons (n=83 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-275.2%0.29 km2P*
2026-10-129.8%0.55 km2P*

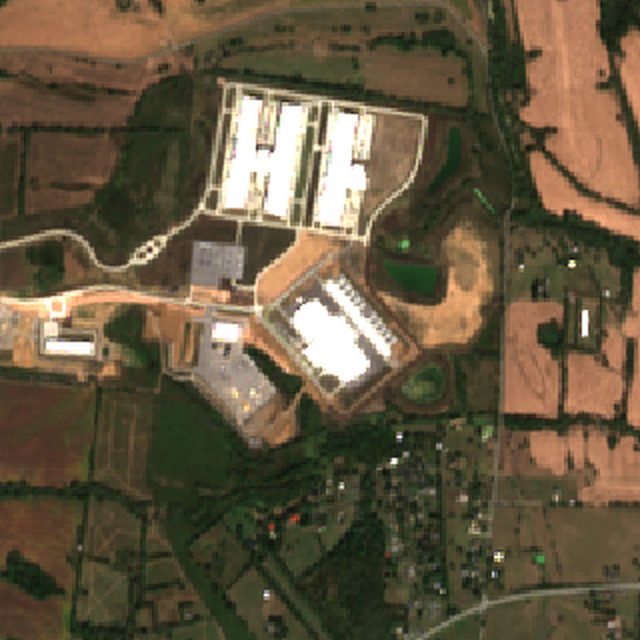

epoch_meta_gallatin

meta - 4.8 km2 window - Epoch map building polygons (n=26 vertices)
latest scenebaseline scene
baseline 2024-10-28latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-287.4%0.35 km2P*
2026-10-133.4%0.16 km2P*

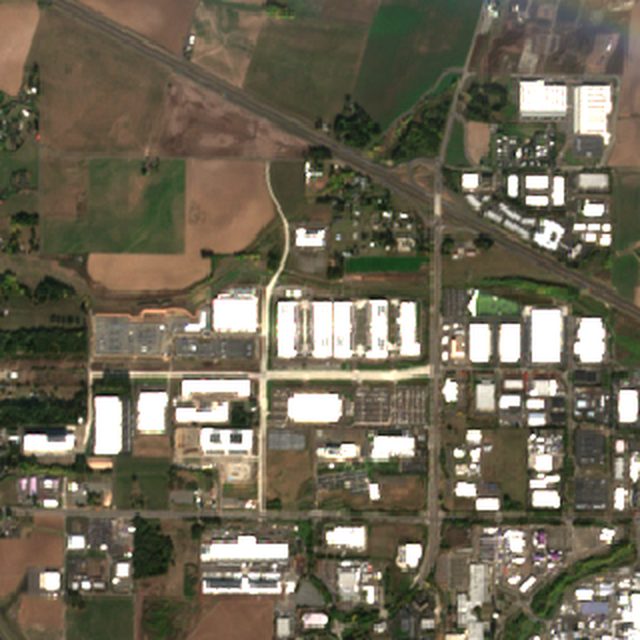

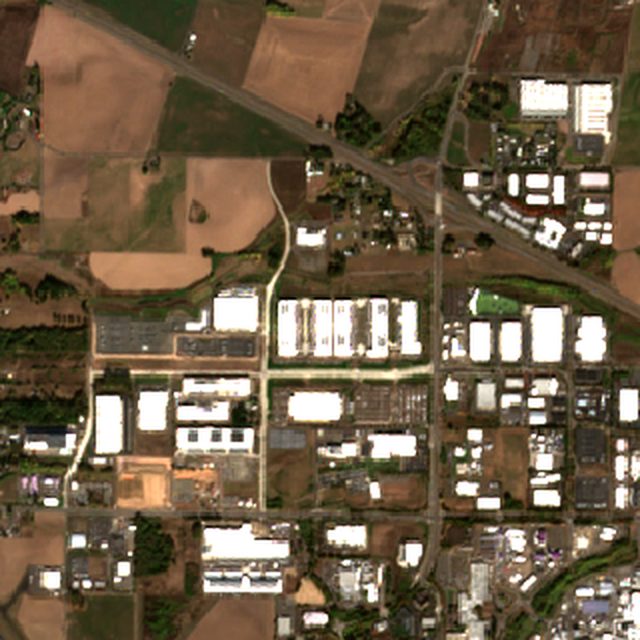

epoch_meta_qts_hillsboro_2

meta - 8.8 km2 window - Epoch map building polygons (n=100 vertices)
latest scenebaseline scene
baseline 2024-10-13latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-1312.2%1.07 km2P*
2026-10-158.3%0.73 km2P*

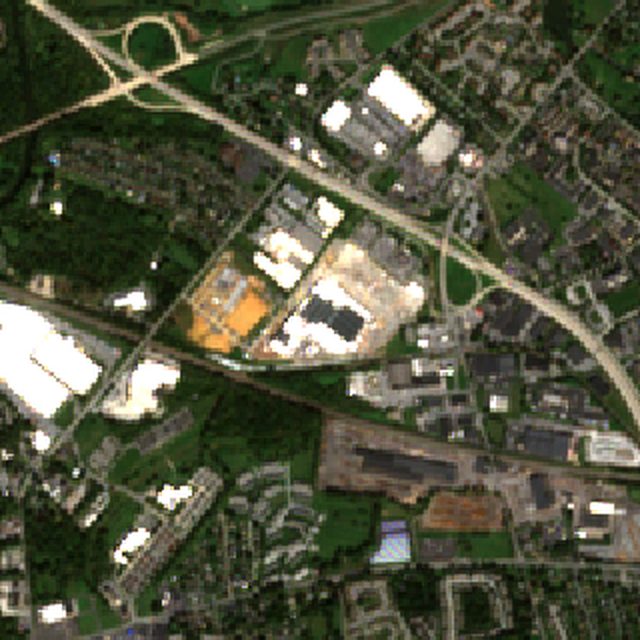

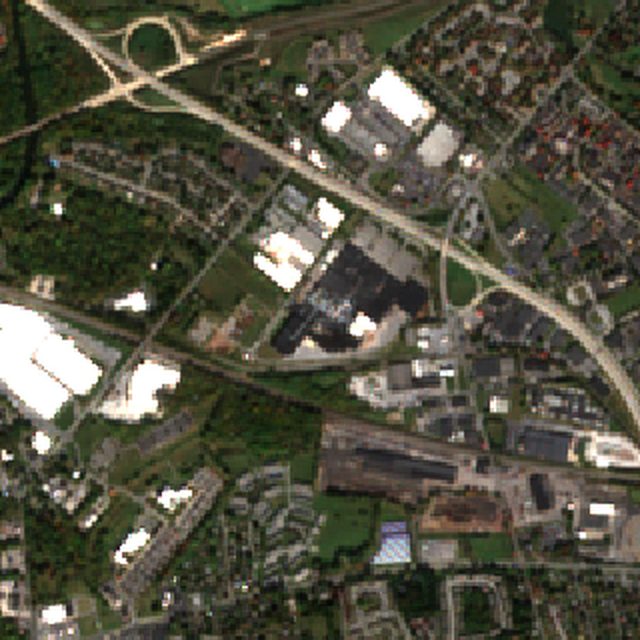

epoch_coreweave_lancaster_greenfield_site

coreweave - 4.4 km2 window - Epoch map building polygons (n=51 vertices)
latest scenebaseline scene
baseline 2024-10-21latest 2026-10-08
SCENEBUILTAREAMETHOD
2024-10-2115.5%0.68 km2P*
2026-10-0811.7%0.52 km2P*

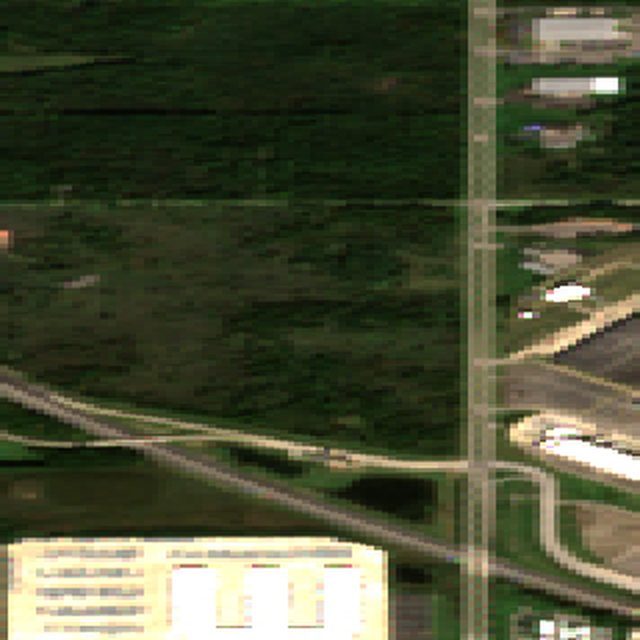

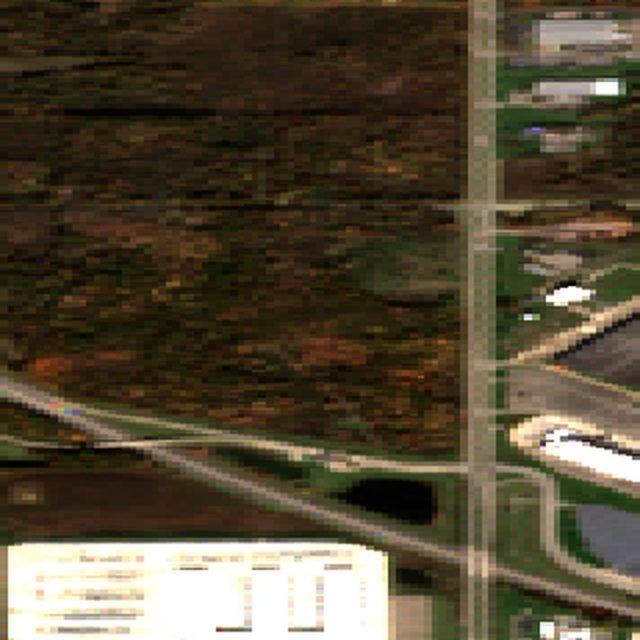

epoch_openai_stargate_lordstown

openai with microsoft, oracle - 4.8 km2 window - Epoch map building polygons (n=10 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-04
SCENEBUILTAREAMETHOD
2024-10-277.6%0.37 km2P*
2026-10-043.9%0.19 km2P*

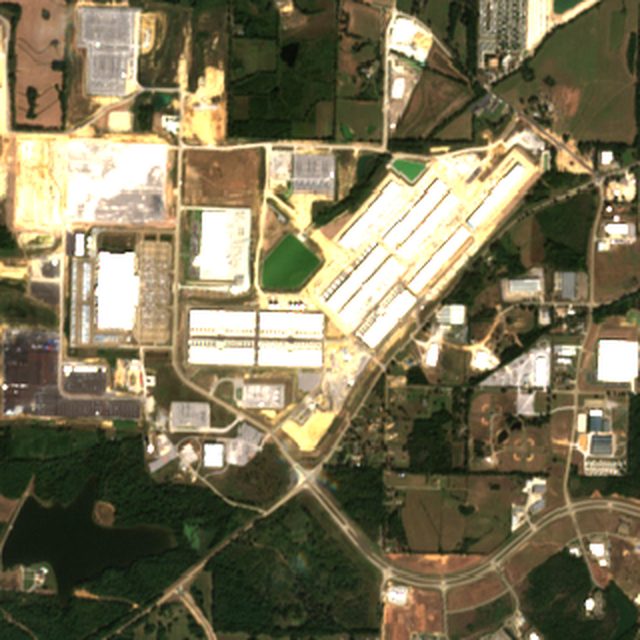

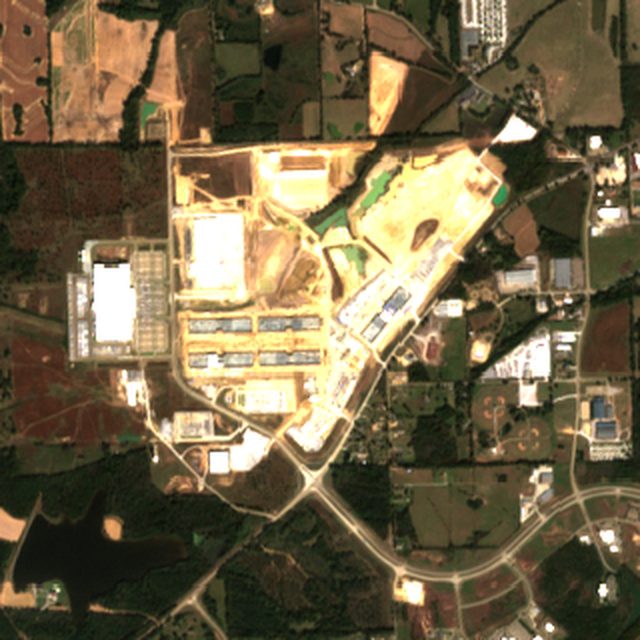

epoch_amazon_madison_mega_site

amazon with anthropic - 9.4 km2 window - Epoch map building polygons (n=143 vertices)
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-263.7%0.35 km2P*
2026-10-137.2%0.67 km2P*

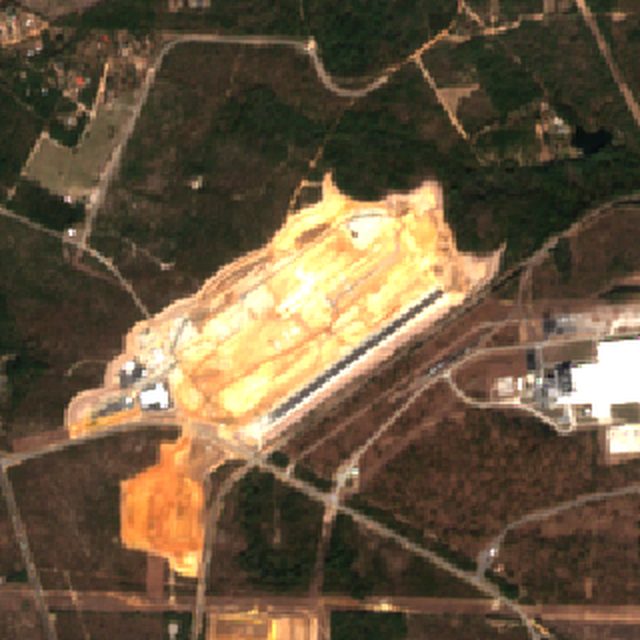

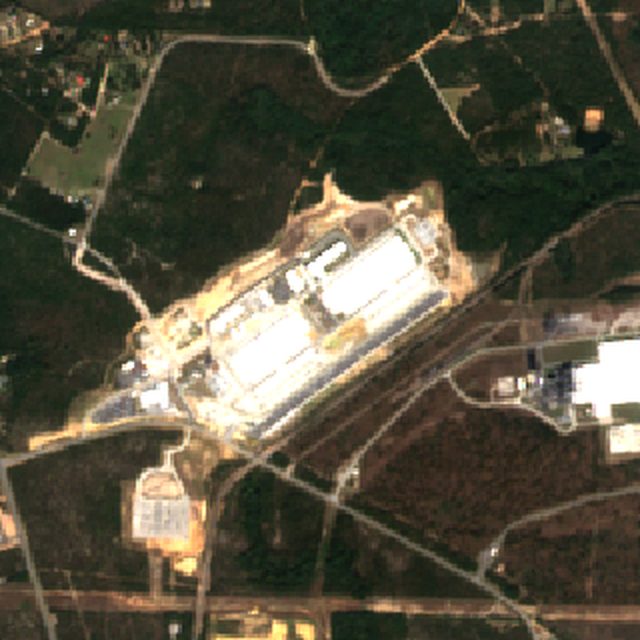

epoch_meta_aiken

meta - 5.1 km2 window - Epoch map building polygons (n=35 vertices)
latest scenebaseline scene
baseline 2024-10-24latest 2026-10-14
SCENEBUILTAREAMETHOD
2024-10-241.6%0.08 km2P*
2026-10-145.1%0.26 km2P*

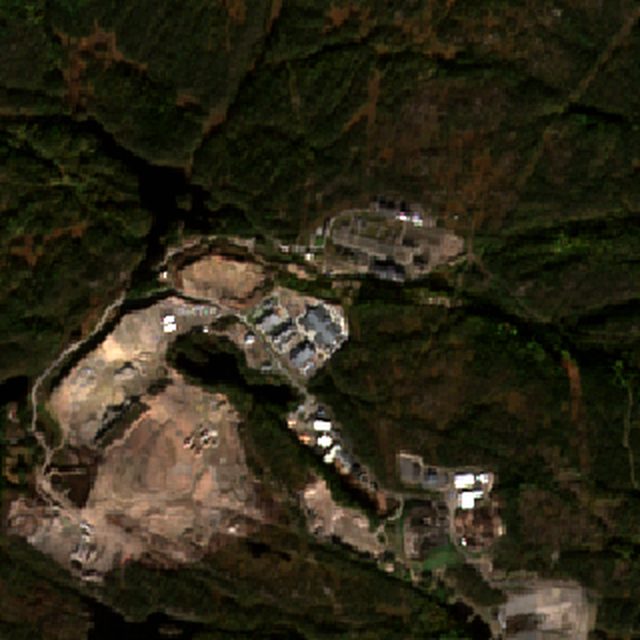

epoch_coreweave_norway

coreweave - 5.9 km2 window - Epoch map building polygons (n=76 vertices)
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-08
SCENEBUILTAREAMETHOD
2024-10-264.4%0.26 km2P*
2026-10-081.0%0.06 km2P*

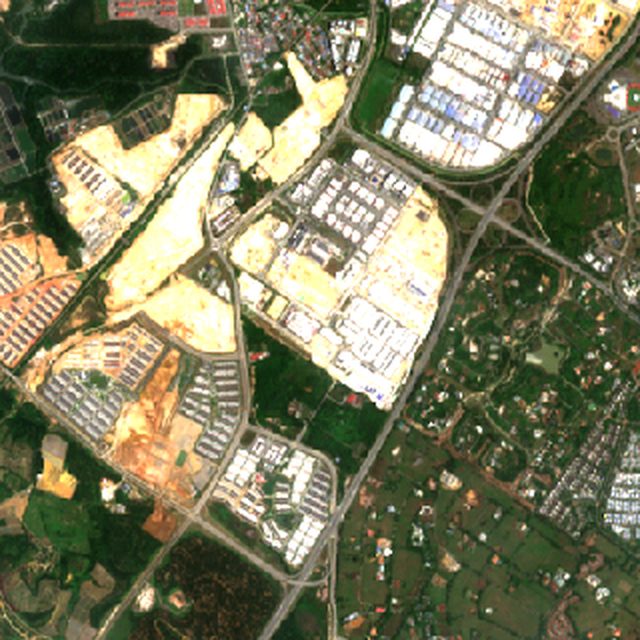

dayone_nusajaya

dayone - 16.0 km2 window - Epoch building polygons (Johor)
latest scenebaseline scene
baseline 2024-08-22latest 2026-10-01
SCENEBUILTAREAMETHOD
2024-08-225.4%0.86 km2P*
2026-10-018.6%1.38 km2P*

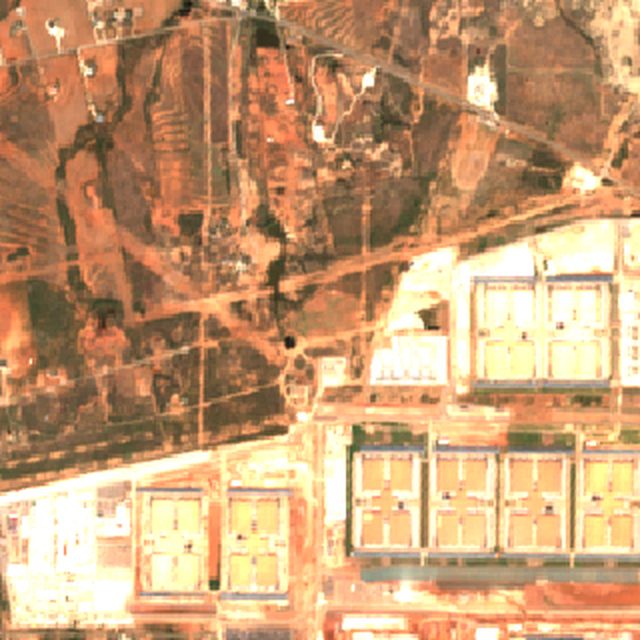

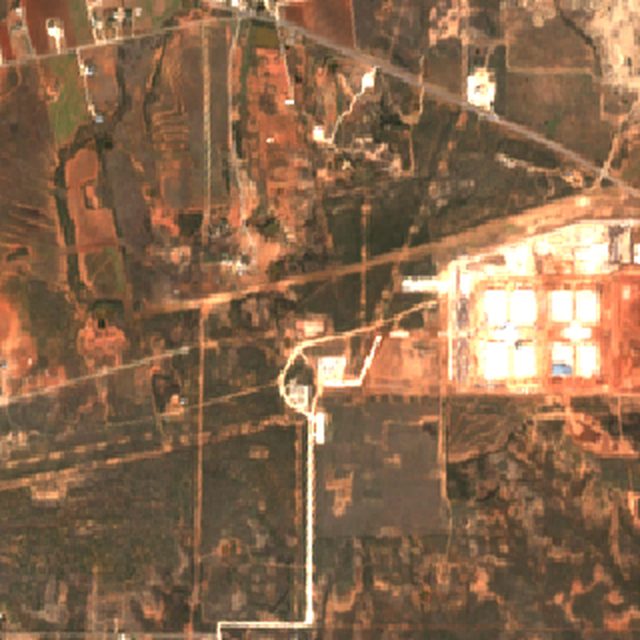

stargate_abilene

crusoe with oracle, openai, microsoft - 6.2 km2 window - Epoch building polygons (verified 2026-10-17)
latest scenebaseline scene
baseline 2024-10-28latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-281.9%0.12 km2P*
2026-10-105.0%0.31 km2P*

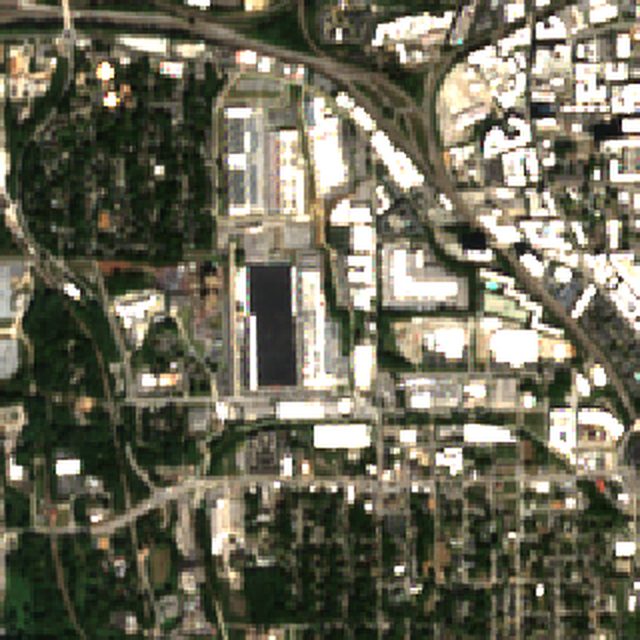

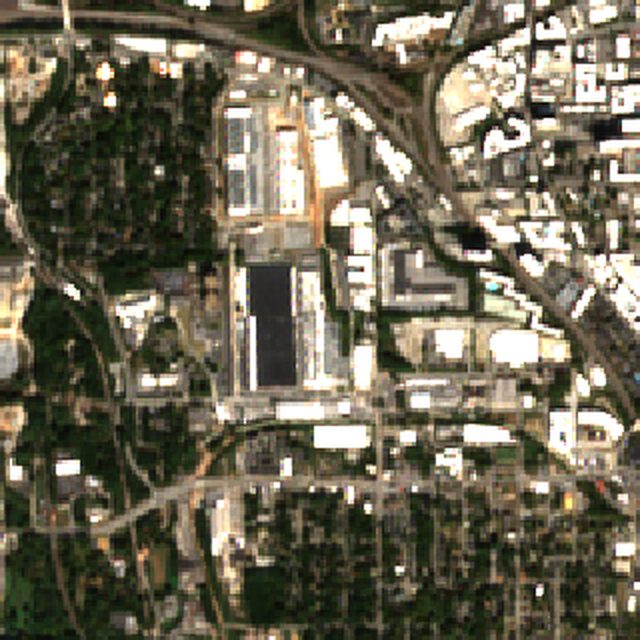

epoch_xai_qts_atlanta

xai - 4.1 km2 window - Epoch map building polygons (n=44 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-2511.1%0.45 km2P*
2026-10-1514.0%0.57 km2P*

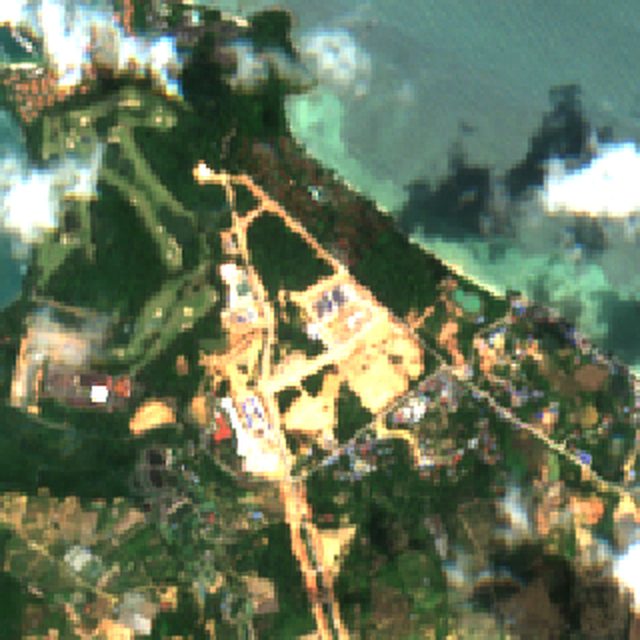

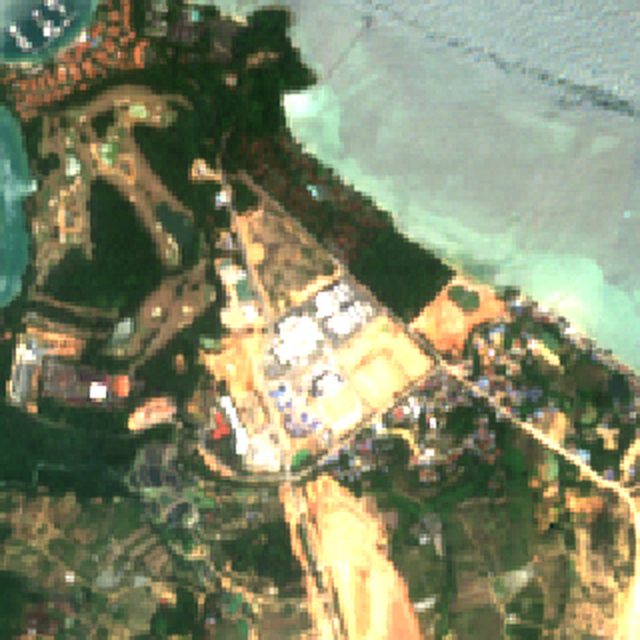

epoch_oracle_batam

oracle with openai, crusoe - 4.0 km2 window - Epoch map building polygons (n=59 vertices)
latest scenebaseline scene
baseline 2024-09-01latest 2026-10-01
SCENEBUILTAREAMETHOD
2024-09-012.0%0.08 km2P
2026-10-014.8%0.19 km2P

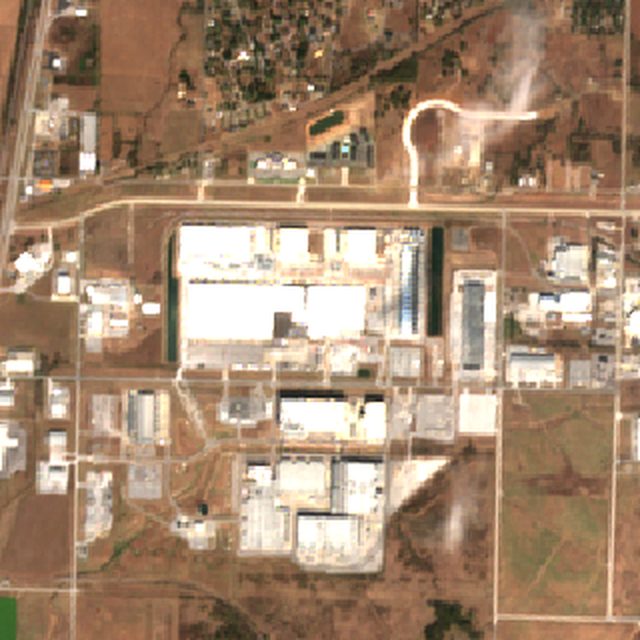

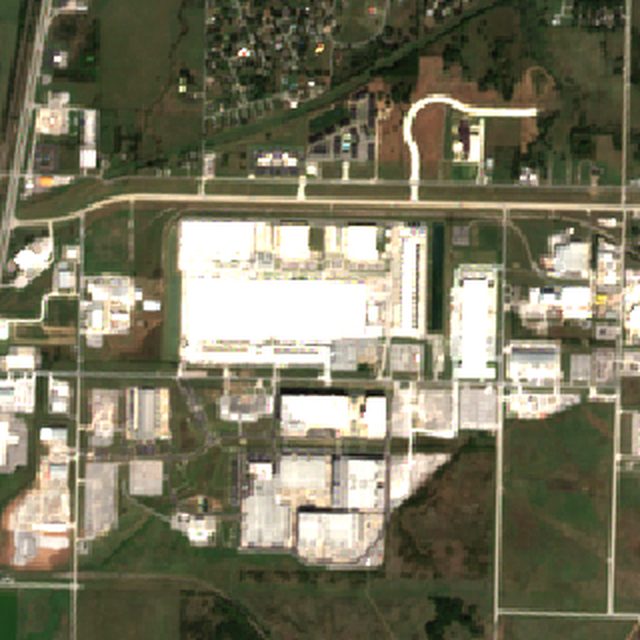

epoch_google_pryor_north

google - 5.7 km2 window - Epoch map building polygons (n=70 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-276.9%0.39 km2P*
2026-10-129.7%0.55 km2P*

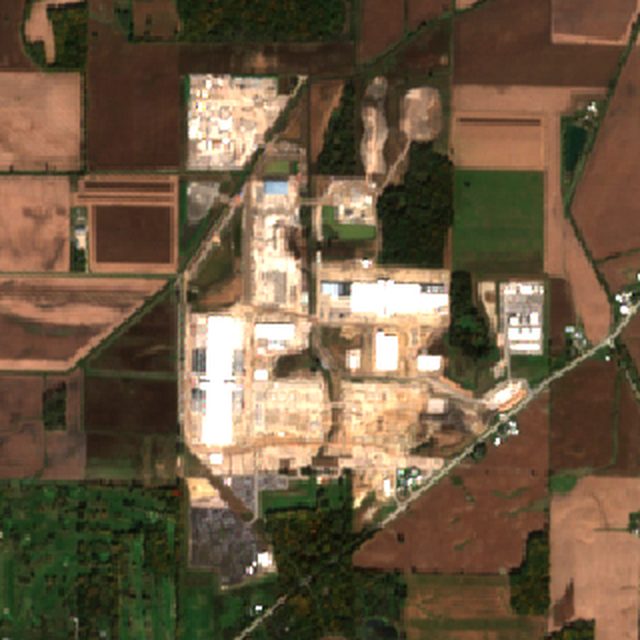

epoch_openai_stargate_michigan

openai with microsoft, oracle - 6.4 km2 window - Epoch map building polygons (n=29 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-250.2%0.01 km2P*
2026-10-132.9%0.18 km2P*

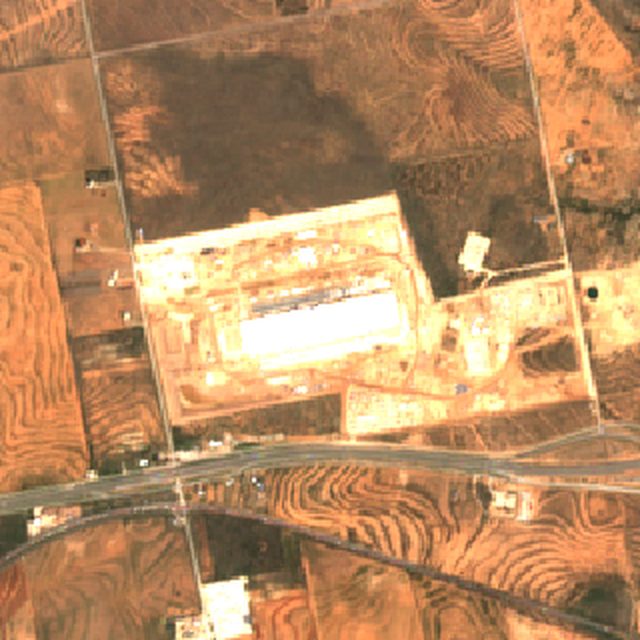

epoch_anthropic_barber_lake

anthropic with amazon - 5.7 km2 window - Epoch map building polygons (n=40 vertices)
latest scenebaseline scene
baseline 2024-10-23latest 2026-10-08
SCENEBUILTAREAMETHOD
2024-10-230.6%0.03 km2P
2026-10-083.0%0.17 km2P

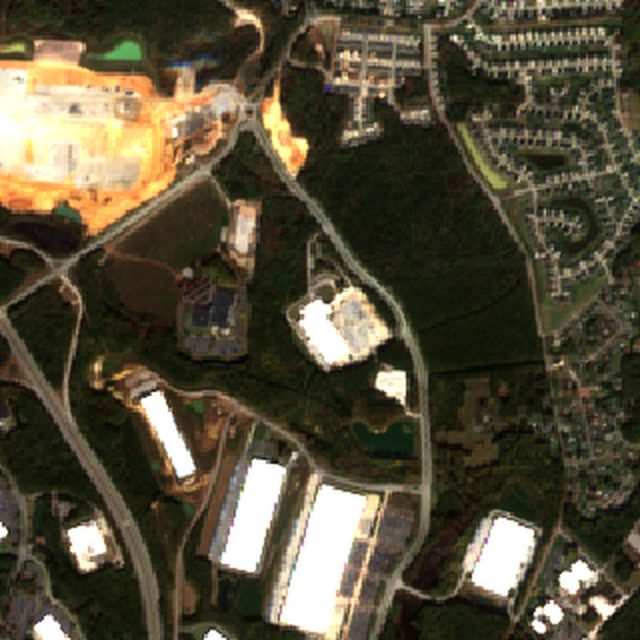

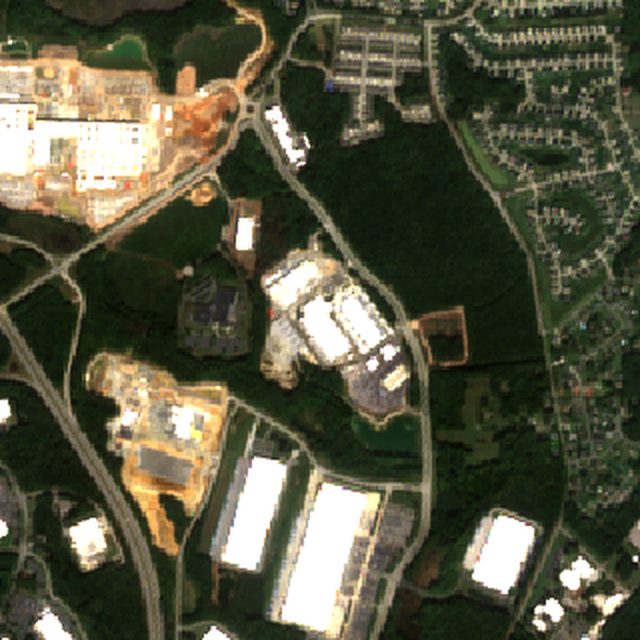

epoch_coreweave_chester_va

coreweave - 5.8 km2 window - Epoch map building polygons (n=52 vertices)
latest scenebaseline scene
baseline 2024-10-31latest 2026-10-16
SCENEBUILTAREAMETHOD
2024-10-317.1%0.41 km2P*
2026-10-169.4%0.54 km2P*

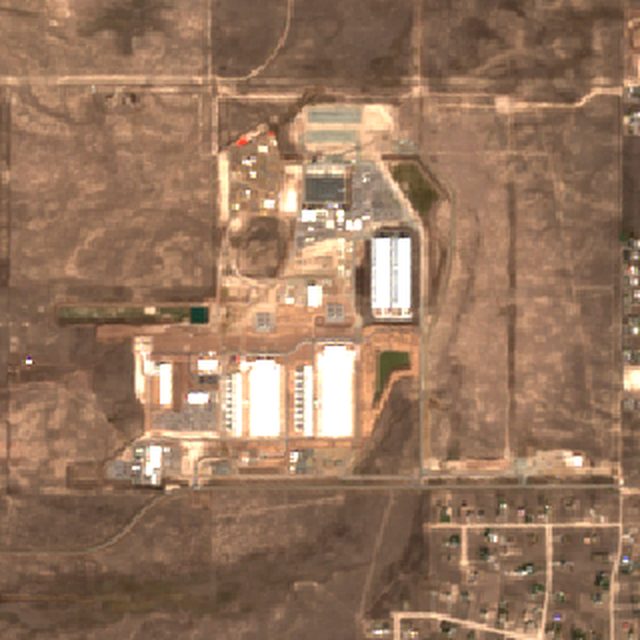

epoch_meta_cheyenne

meta - 6.4 km2 window - Epoch map building polygons (n=43 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-270.1%0.01 km2P*
2026-10-122.4%0.15 km2P*

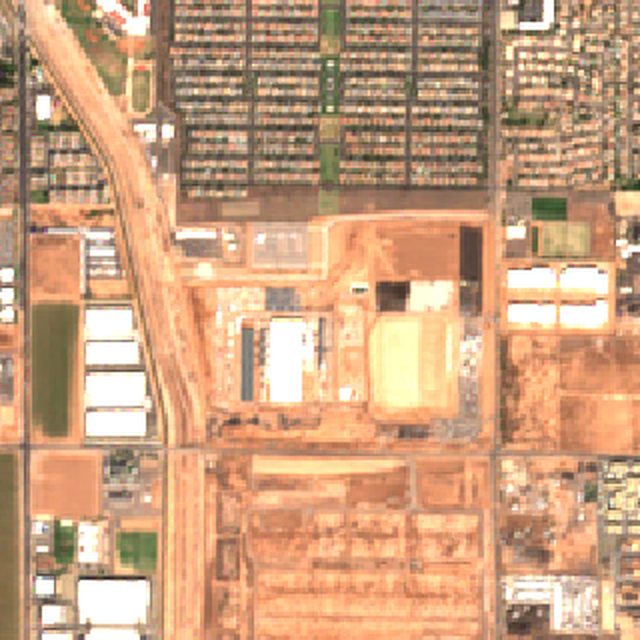

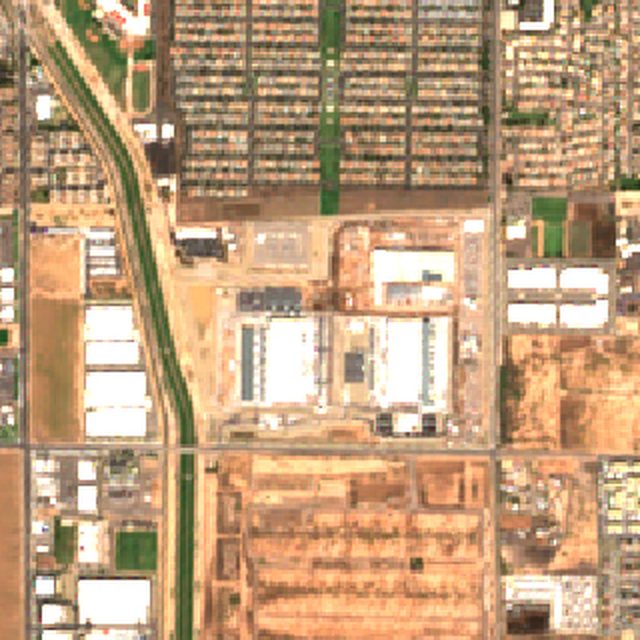

epoch_google_mesa

google - 4.5 km2 window - Epoch map building polygons (n=48 vertices)
latest scenebaseline scene
baseline 2024-10-30latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-305.5%0.25 km2P*
2026-10-157.7%0.35 km2P*

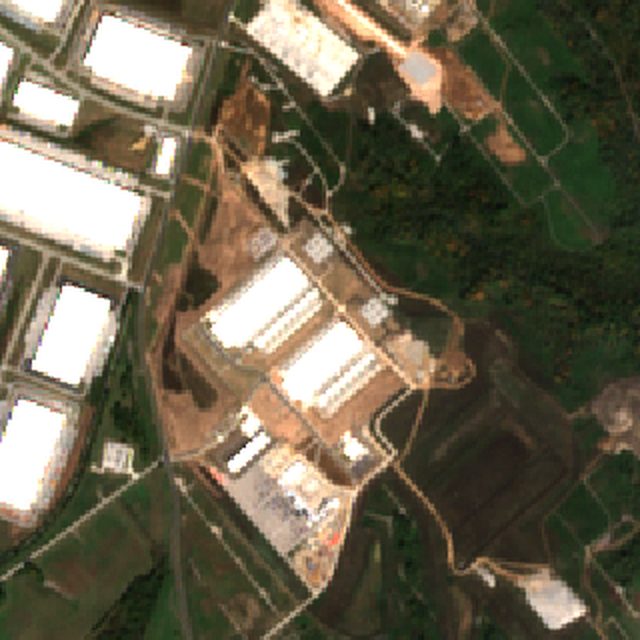

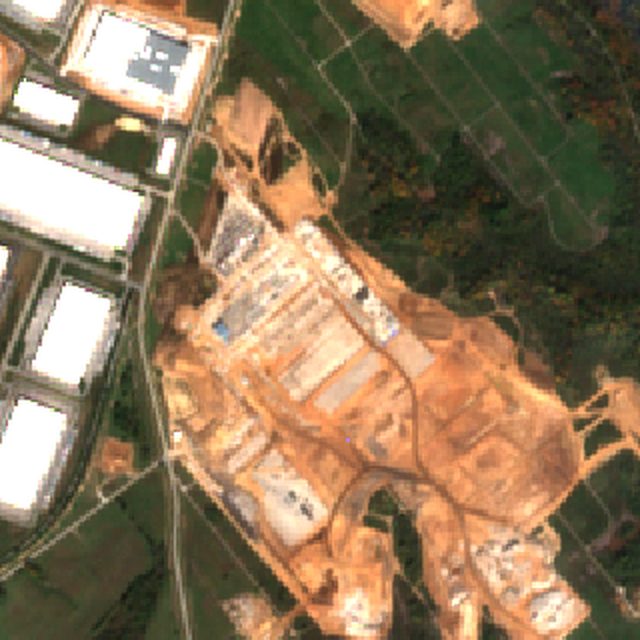

epoch_meta_jeffersonville

meta - 4.4 km2 window - Epoch map building polygons (n=33 vertices)
latest scenebaseline scene
baseline 2024-10-23latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-236.9%0.30 km2P*
2026-10-139.1%0.40 km2P*

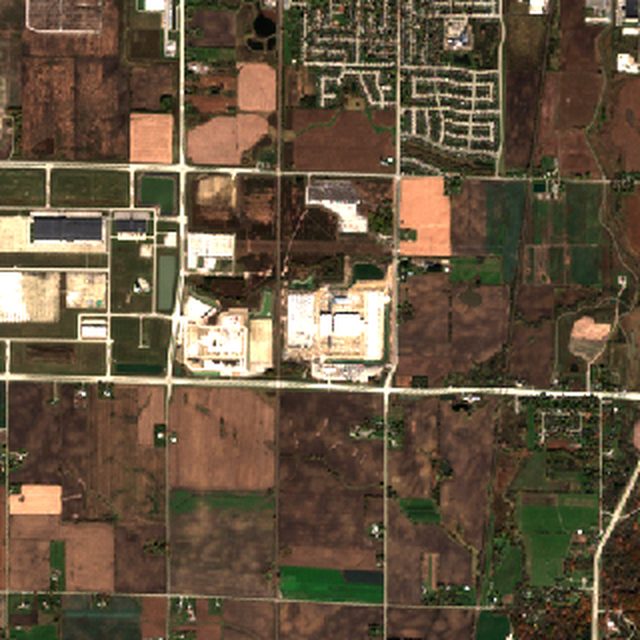

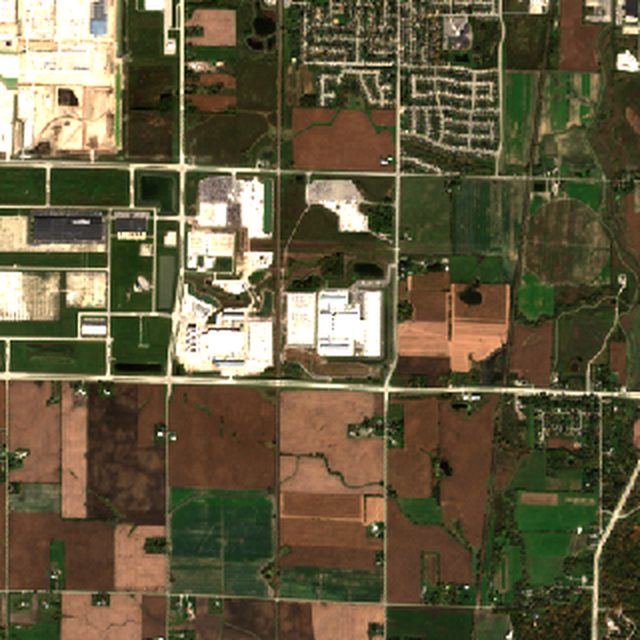

epoch_microsoft_fairwater_wisconsin

microsoft with openai - 22.5 km2 window - Epoch map building polygons (n=112 vertices)
latest scenebaseline scene
baseline 2024-10-26latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-261.9%0.43 km2P*
2026-10-133.9%0.88 km2P*

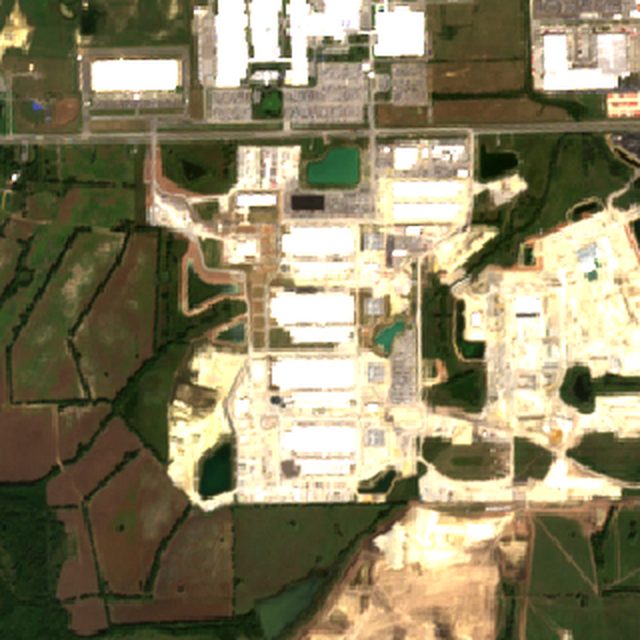

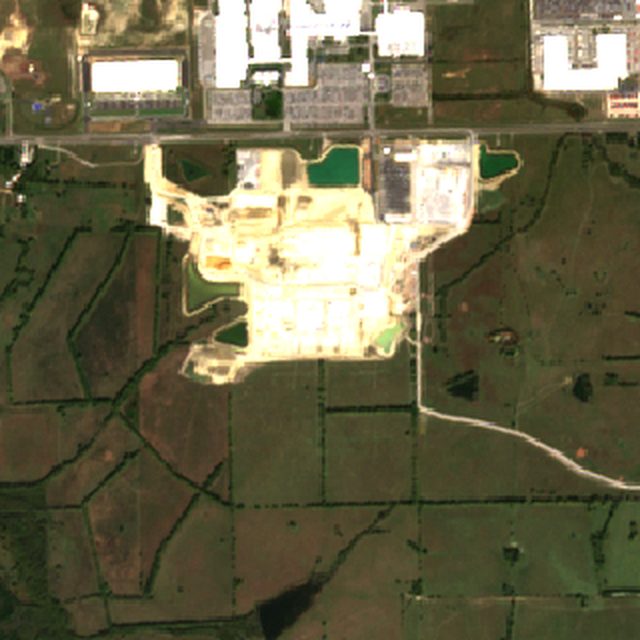

epoch_meta_montgomery

meta - 7.6 km2 window - Epoch map building polygons (n=109 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-256.4%0.49 km2P*
2026-10-078.4%0.64 km2P*

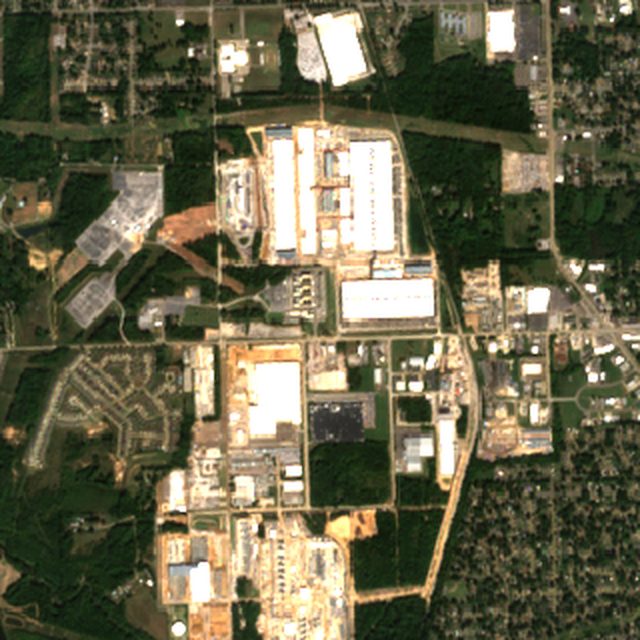

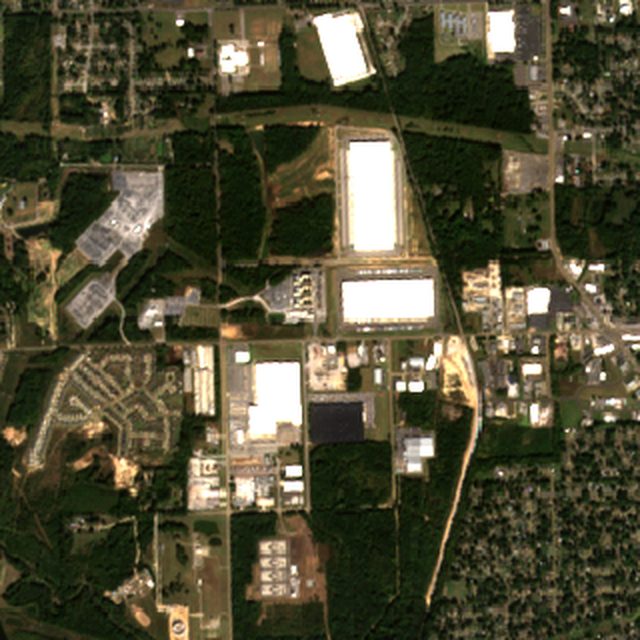

colossus2_memphis

xai with spacexai - 9.0 km2 window - Epoch building polygons (5420 Tulane Rd)
latest scenebaseline scene
baseline 2024-10-21latest 2026-10-11
SCENEBUILTAREAMETHOD
2024-10-214.9%0.44 km2P*
2026-10-116.9%0.62 km2P*

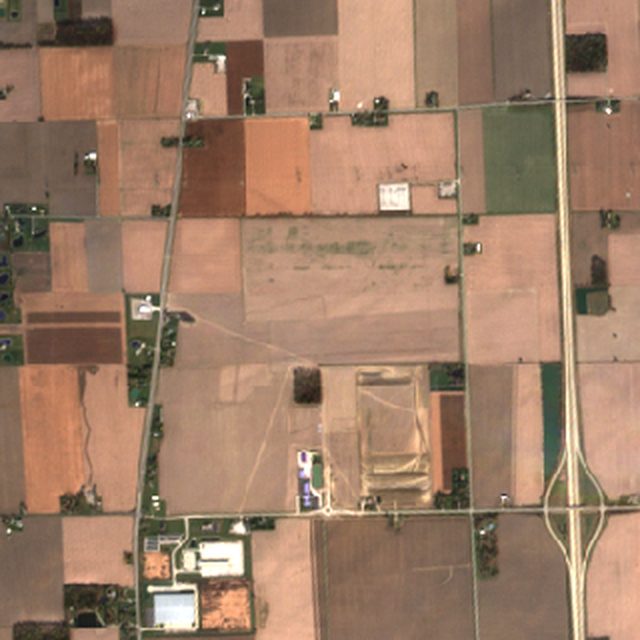

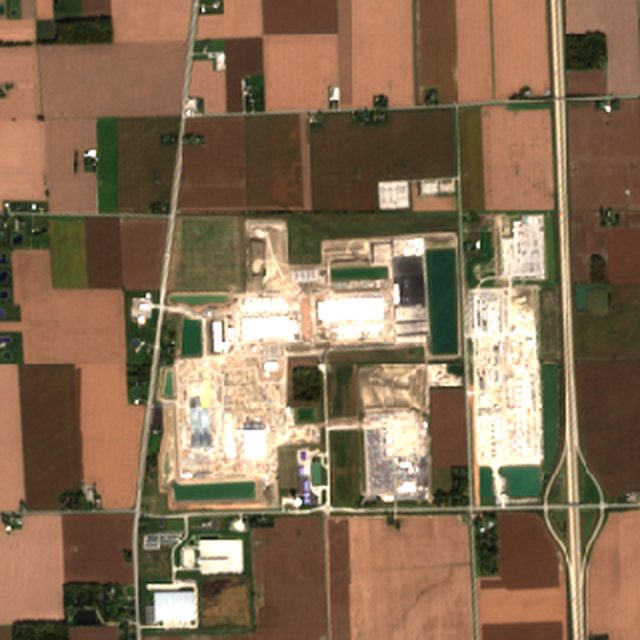

epoch_meta_bowling_green

meta - 11.3 km2 window - Epoch map building polygons (n=73 vertices)
latest scenebaseline scene
baseline 2024-10-30latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-301.2%0.14 km2P*
2026-10-133.1%0.35 km2P*

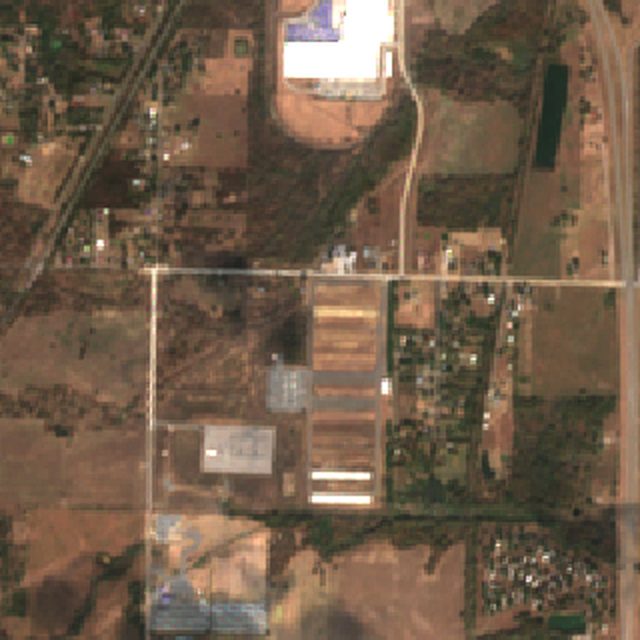

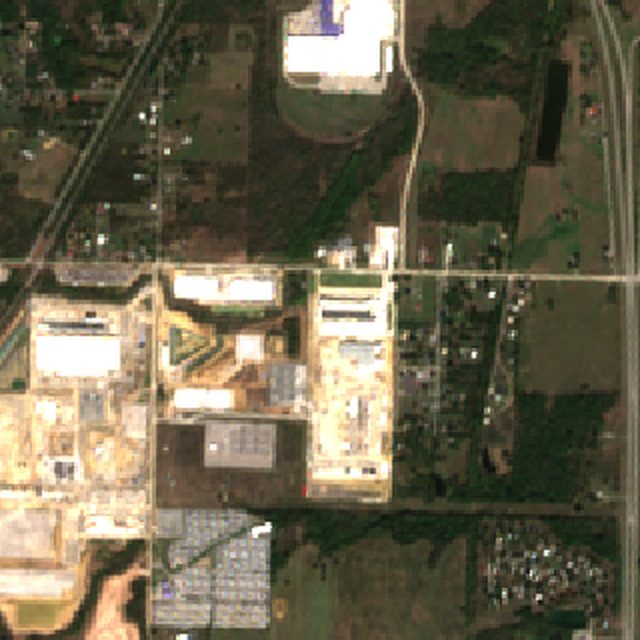

epoch_coreweave_muskogee_ok

coreweave - 4.3 km2 window - Epoch map building polygons (n=33 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-273.1%0.13 km2P*
2026-10-124.9%0.21 km2P*

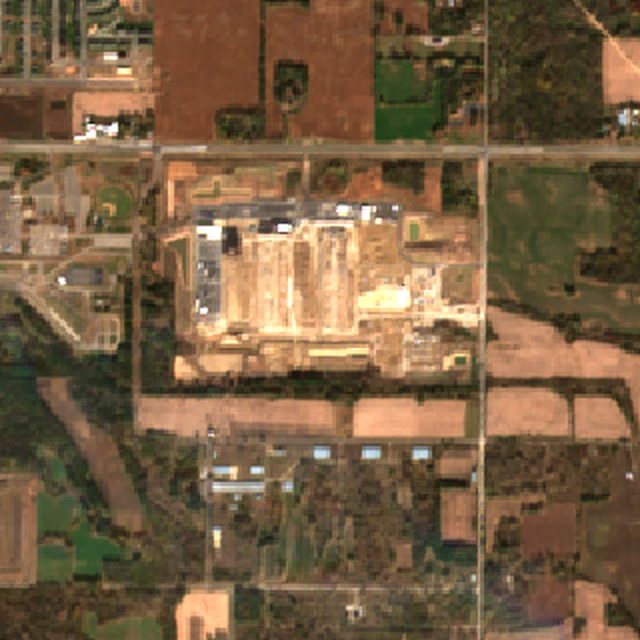

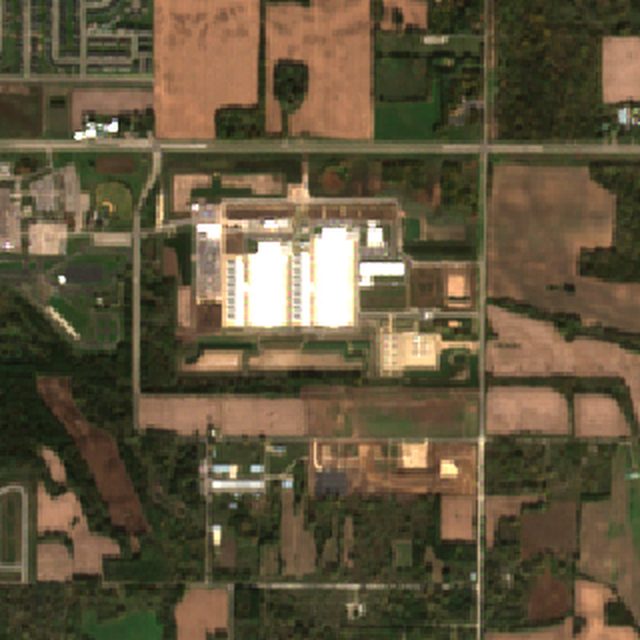

epoch_meta_rosemount

meta - 5.4 km2 window - Epoch map building polygons (n=33 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-270.7%0.04 km2P*
2026-10-122.4%0.13 km2P*

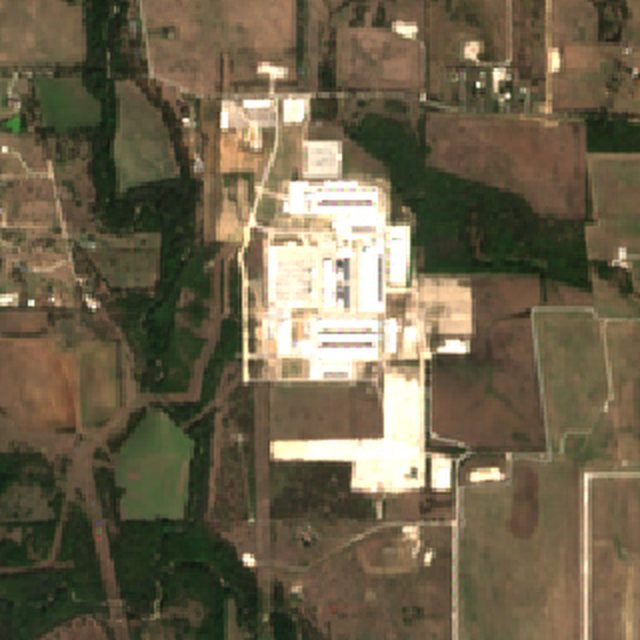

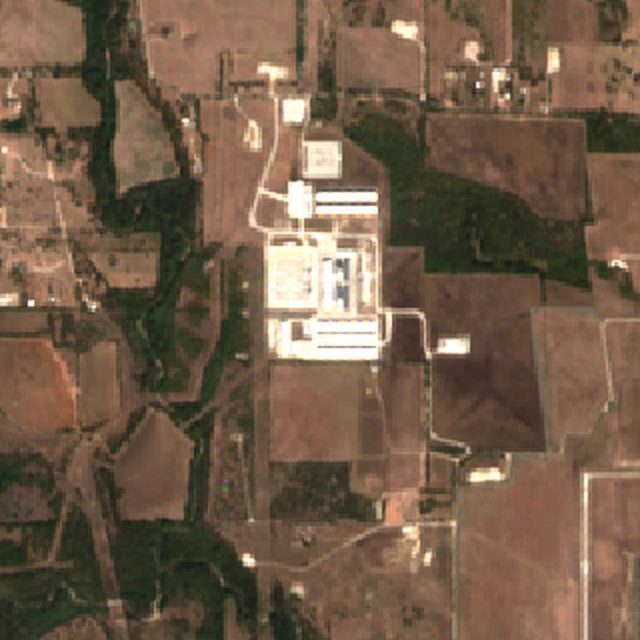

epoch_coreweave_denton_tx

coreweave - 4.8 km2 window - Epoch map building polygons (n=143 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-251.4%0.07 km2P*
2026-10-103.0%0.15 km2P*

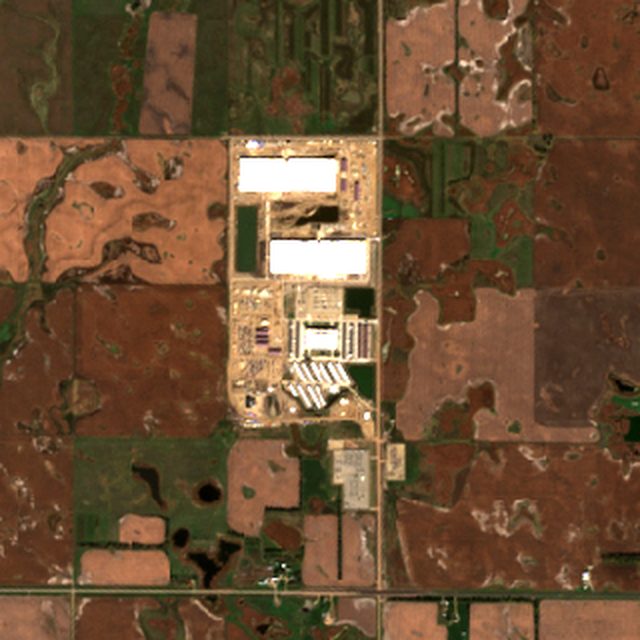

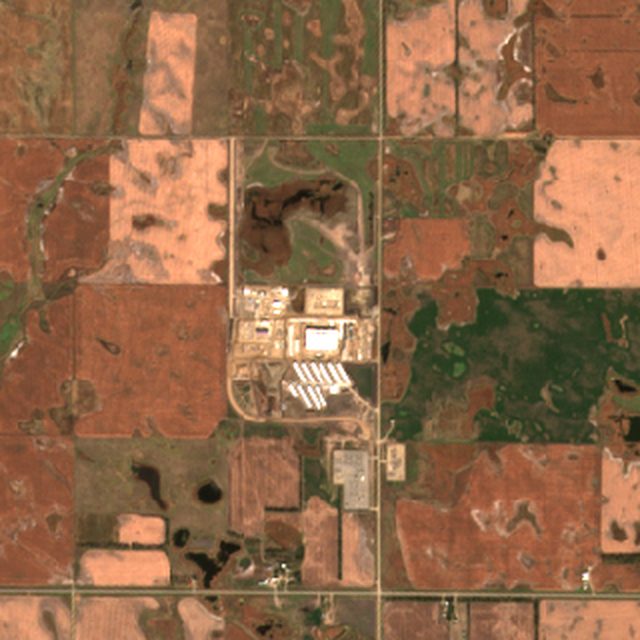

epoch_coreweave_ellendale_nd

coreweave - 11.2 km2 window - Epoch map building polygons (n=53 vertices)
latest scenebaseline scene
baseline 2024-10-16latest 2026-10-16
SCENEBUILTAREAMETHOD
2024-10-160.4%0.04 km2P*
2026-10-161.9%0.21 km2P*

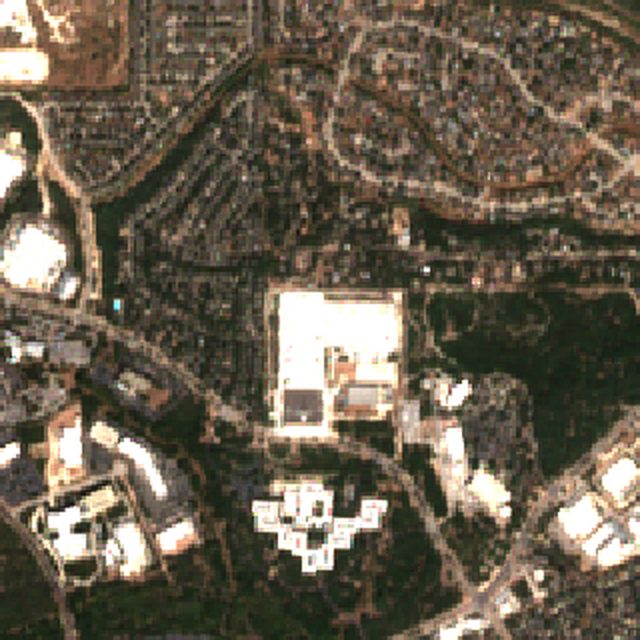

epoch_microsoft_sat14

microsoft with openai - 4.0 km2 window - Epoch map building polygons (n=58 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-259.8%0.39 km2P
2026-10-108.6%0.34 km2P

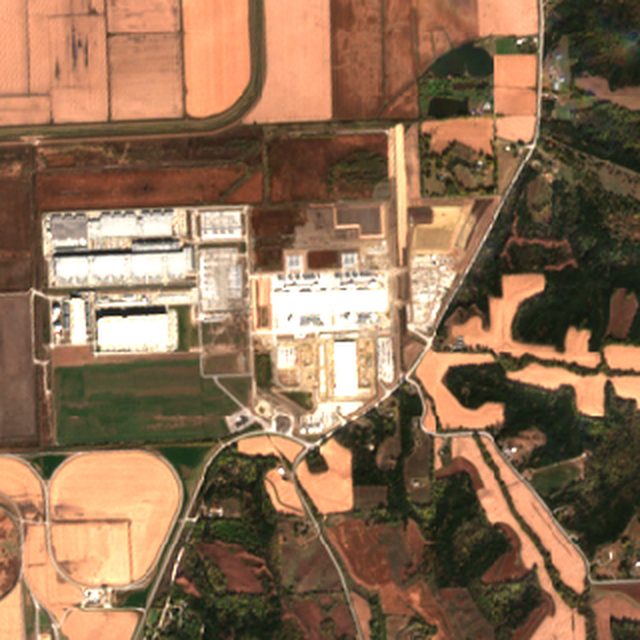

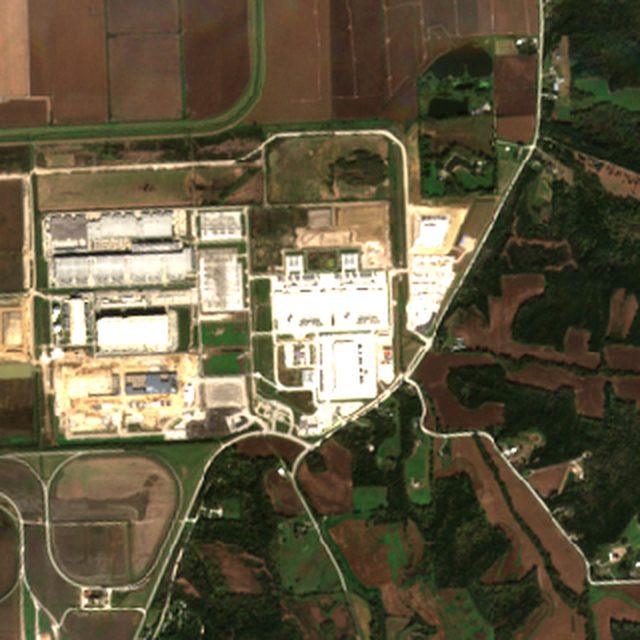

epoch_google_council_bluffs_east

google - 10.1 km2 window - Epoch map building polygons (n=99 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-253.1%0.31 km2P*
2026-10-124.2%0.42 km2P*

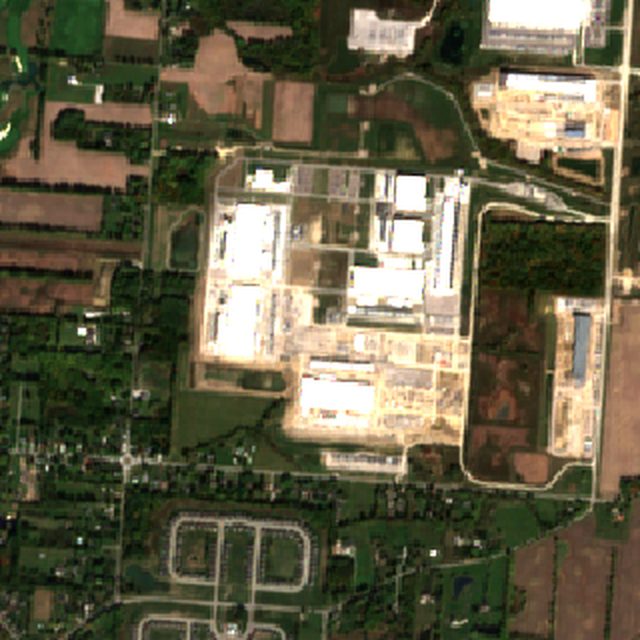

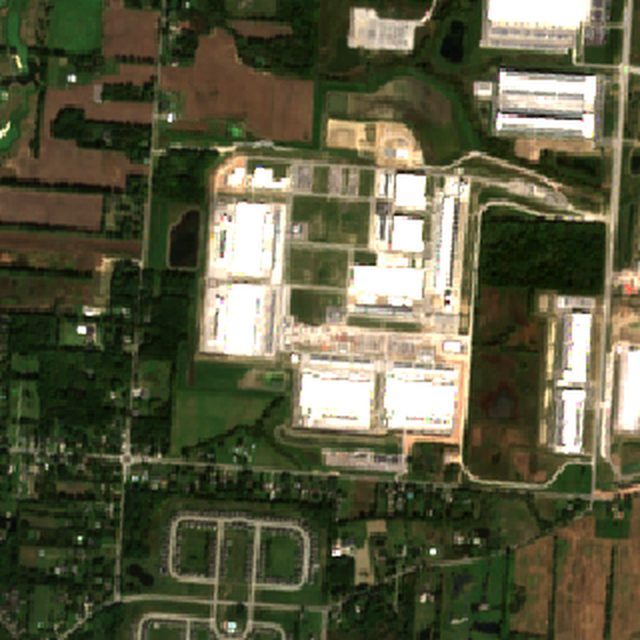

epoch_google_new_albany

google - 6.1 km2 window - Epoch map building polygons (n=118 vertices)
latest scenebaseline scene
baseline 2024-10-20latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-205.7%0.34 km2P*
2026-10-076.8%0.41 km2P*

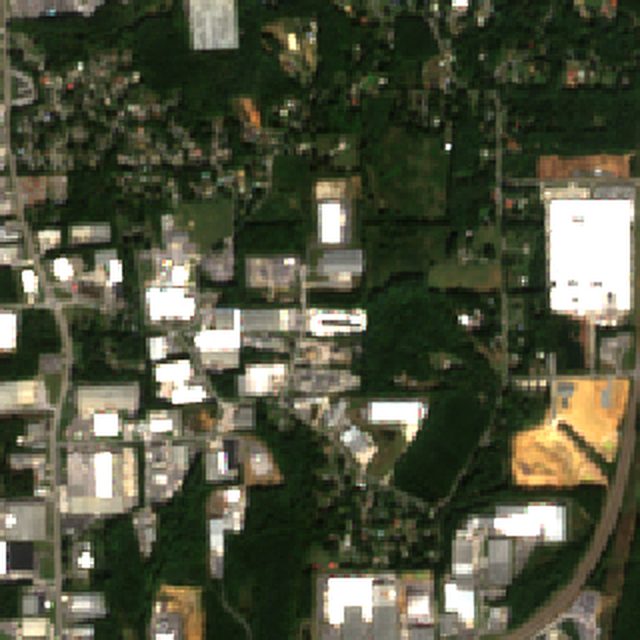

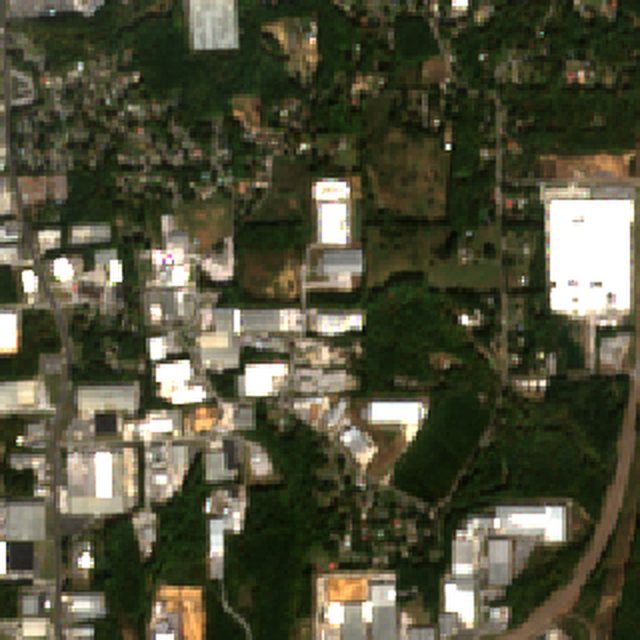

epoch_coreweave_dalton_1_2

coreweave - 4.0 km2 window - Epoch map building polygons (n=20 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-257.6%0.30 km2P*
2026-10-158.7%0.35 km2P*

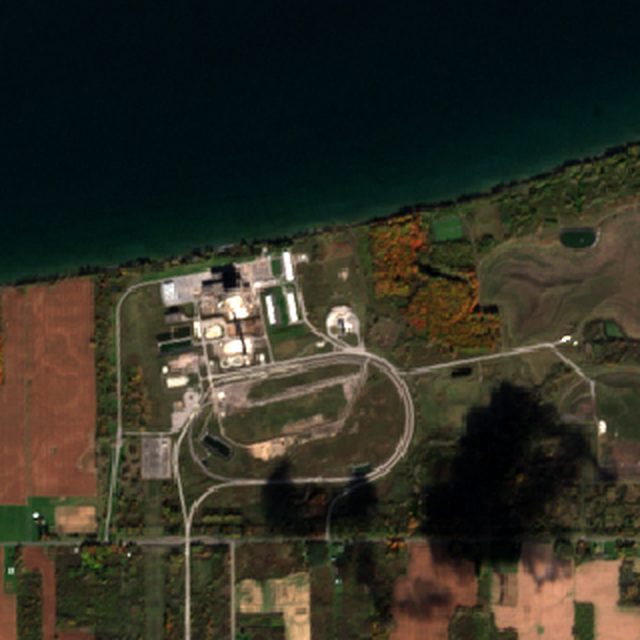

epoch_anthropic_lake_mariner

anthropic with amazon - 7.8 km2 window - Epoch map building polygons (n=33 vertices)
latest scenebaseline scene
baseline 2024-10-24latest 2026-10-09
SCENEBUILTAREAMETHOD
2024-10-240.9%0.07 km2P*
2026-10-091.9%0.15 km2P*

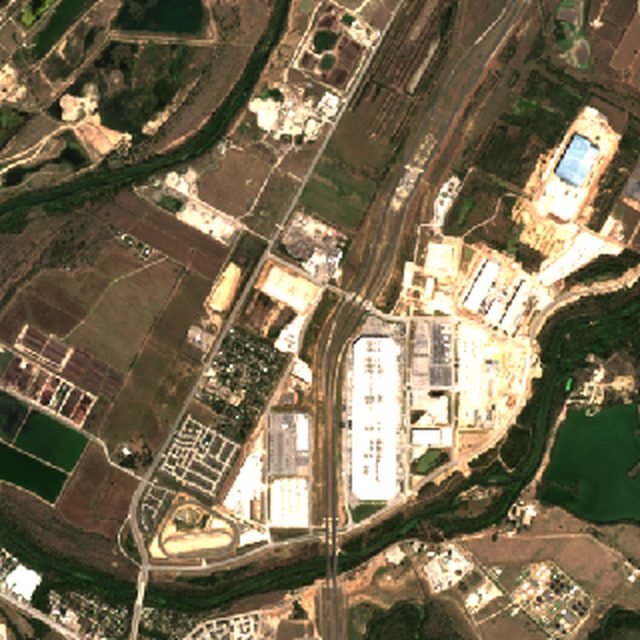

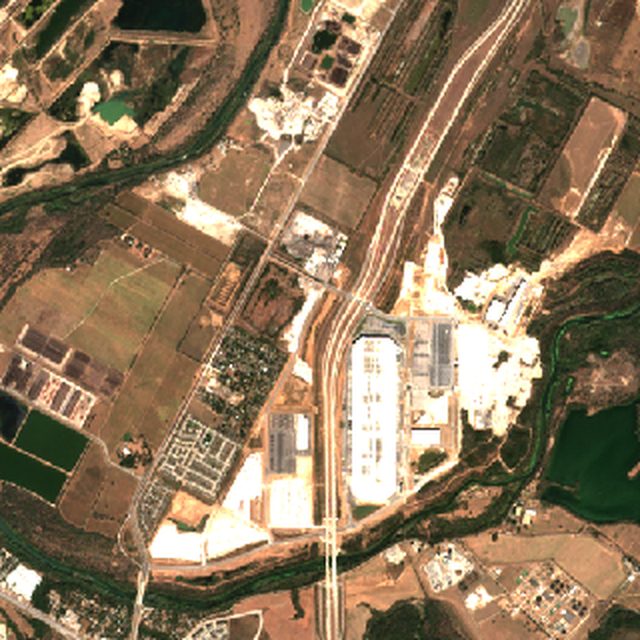

tesla_giga_texas

tesla - 25.0 km2 window - known Giga Texas site (Austin)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-275.5%1.38 km2P*
2026-10-104.6%1.15 km2P*

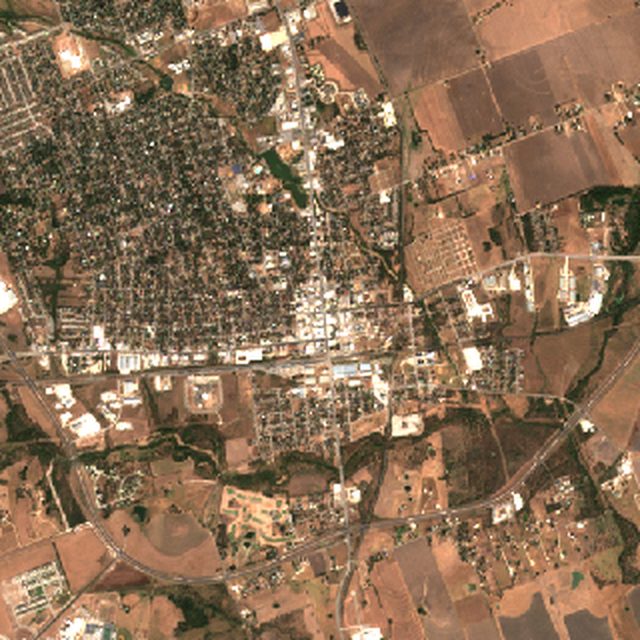

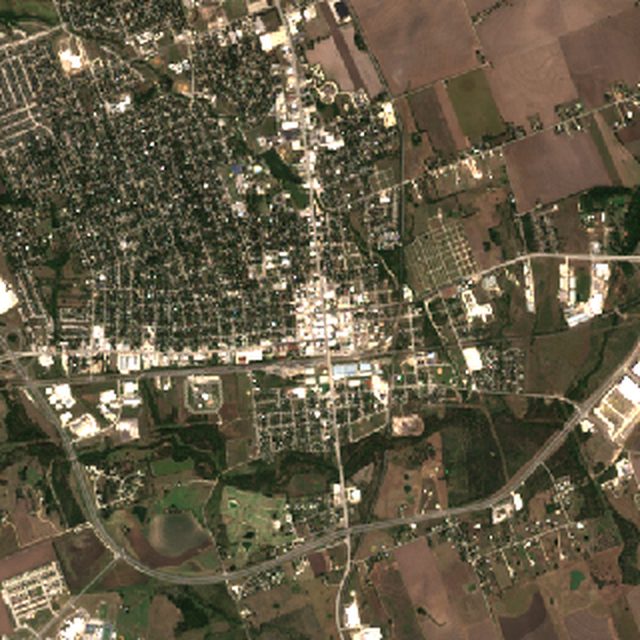

samsung_taylor

samsung - 25.0 km2 window - APPROX Taylor TX fab -- pin from filings
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-271.9%0.47 km2P*
2026-10-102.7%0.68 km2P*

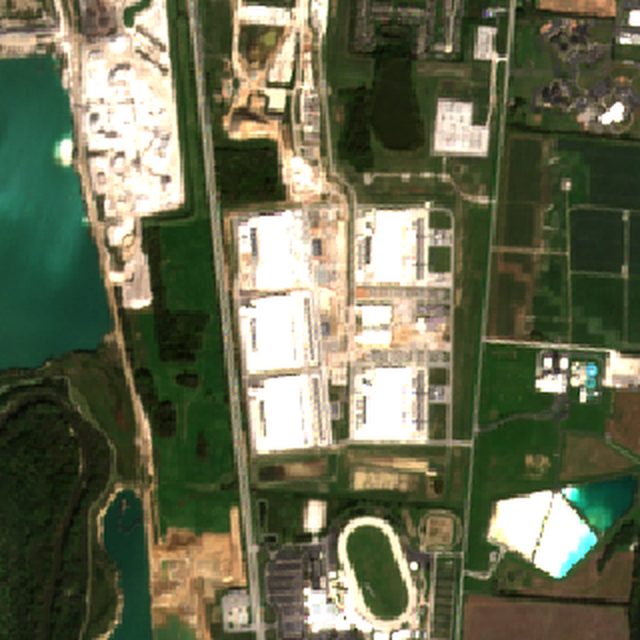

epoch_google_columbus

google - 5.9 km2 window - Epoch map building polygons (n=110 vertices)
latest scenebaseline scene
baseline 2024-10-20latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-207.6%0.45 km2P*
2026-10-078.3%0.49 km2P*

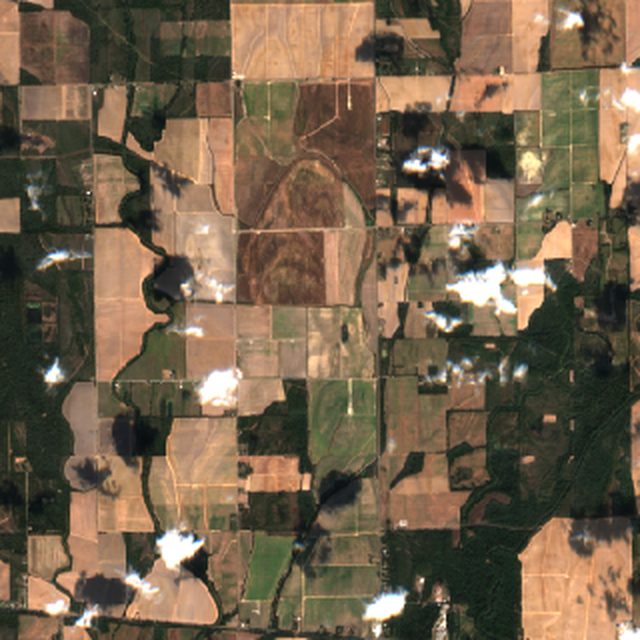

epoch_meta_hyperion

meta - 51.8 km2 window - Epoch map building polygons (n=140 vertices)
latest scenebaseline scene
baseline 2024-10-29latest 2026-10-14

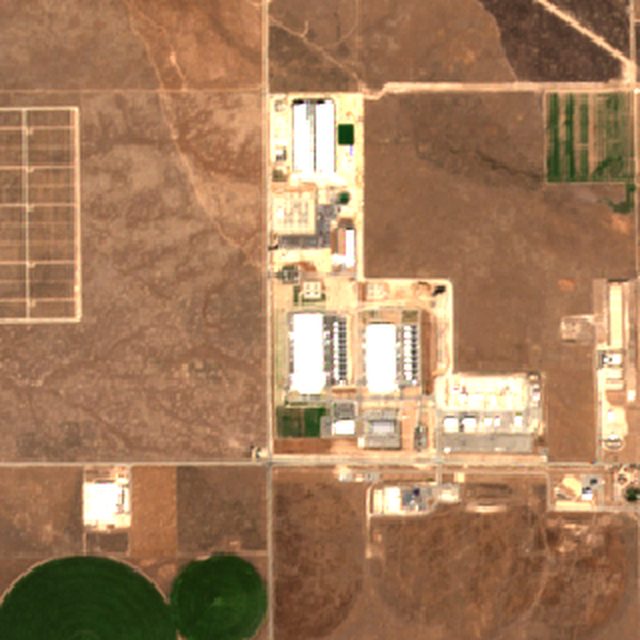

SCENEBUILTAREAMETHOD
2024-10-291.9%0.98 km2P*
2026-10-142.6%1.35 km2P*

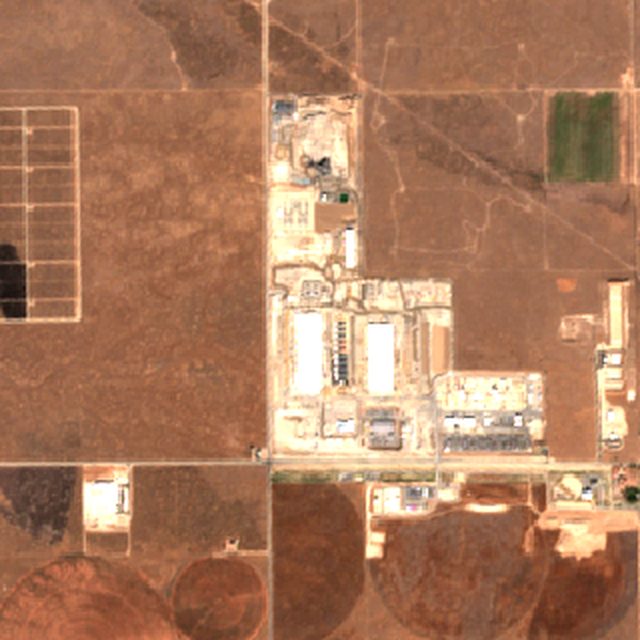

epoch_meta_kuna

meta - 7.6 km2 window - Epoch map building polygons (n=62 vertices)
latest scenebaseline scene
baseline 2024-10-29latest 2026-10-16
SCENEBUILTAREAMETHOD
2024-10-291.8%0.14 km2P*
2026-10-162.5%0.19 km2P*

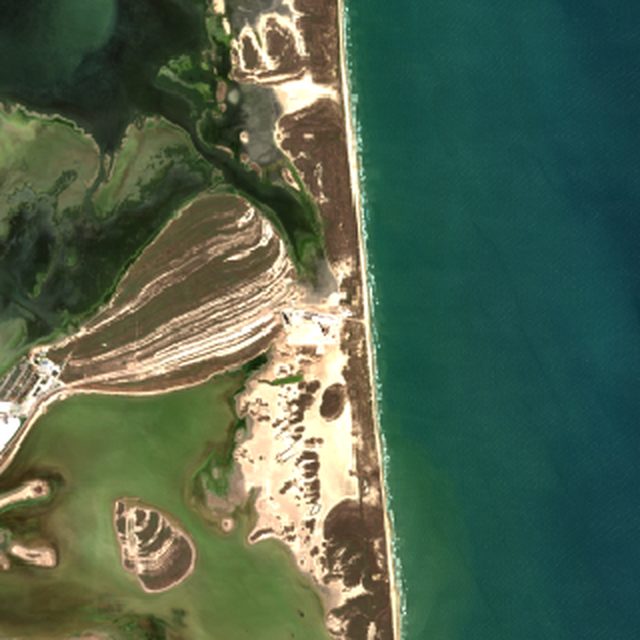

starbase

spacex with starlink - 36.0 km2 window - known launch/production site
latest scenebaseline scene
baseline 2024-10-27latest 2026-09-27
SCENEBUILTAREAMETHOD
2024-10-270.3%0.11 km2P*
2026-09-270.9%0.32 km2P*

epoch_openai_stargate_new_mexico

openai with microsoft, oracle - 62.4 km2 window - Epoch map building polygons (n=3 vertices)
latest scenebaseline scene
baseline 2024-10-24latest 2026-10-14
SCENEBUILTAREAMETHOD
2024-10-241.2%0.75 km2P*
2026-10-141.7%1.06 km2P*

epoch_microsoft_project_osmium

microsoft with openai - 5.4 km2 window - Epoch map building polygons (n=78 vertices)
latest scenebaseline scene

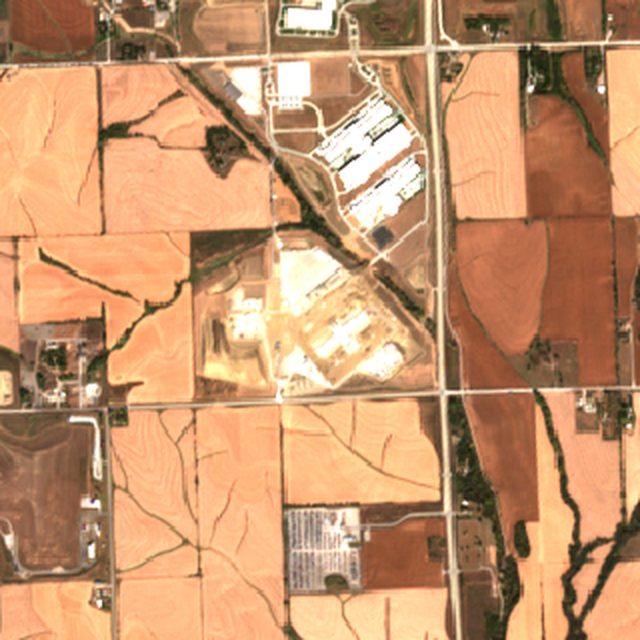

baseline 2024-10-27latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-274.3%0.23 km2P*
2026-10-124.8%0.26 km2P*

epoch_meta_sarpy

meta - 8.4 km2 window - Epoch map building polygons (n=29 vertices)
latest scenebaseline scene
baseline 2024-10-20latest 2026-10-12
SCENEBUILTAREAMETHOD
2024-10-202.7%0.23 km2P*
2026-10-123.2%0.27 km2P*

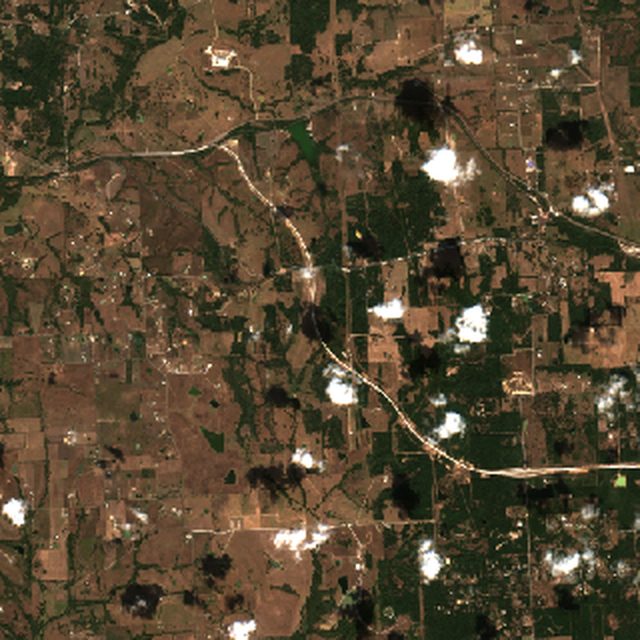

terafab_grimes

terafab with tesla, spacex - 100.0 km2 window - APPROX Plantersville/Hwy-105 corridor -- pin from WIT Tech deeds before print use
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-270.7%0.70 km2P*
2026-10-070.2%0.20 km2P*

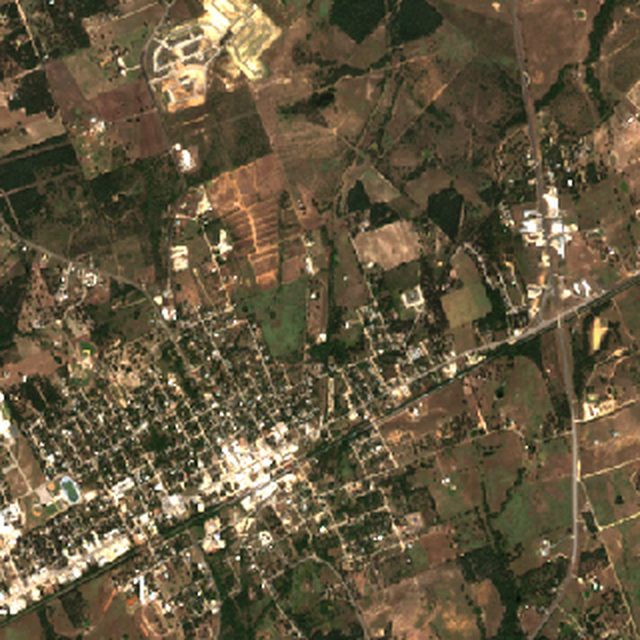

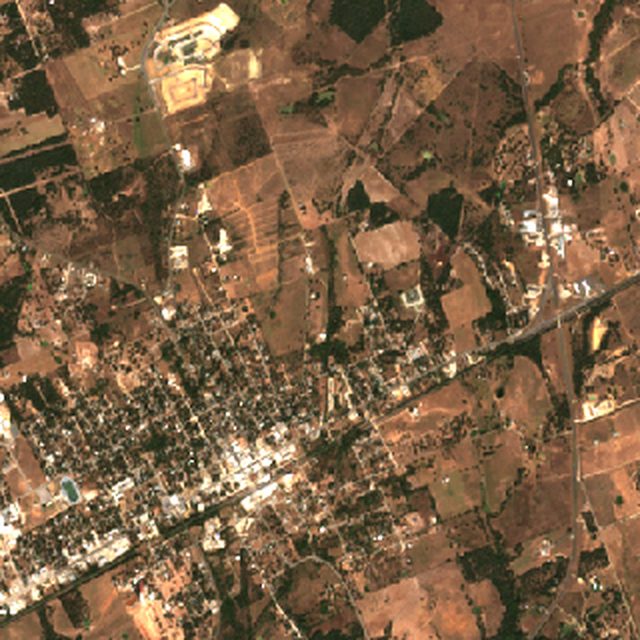

riot_rockdale

riot with anthropic - 16.0 km2 window - former Alcoa smelter site (Sandow Lakes)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-07
SCENEBUILTAREAMETHOD
2024-10-270.7%0.11 km2P*
2026-10-071.1%0.18 km2P*

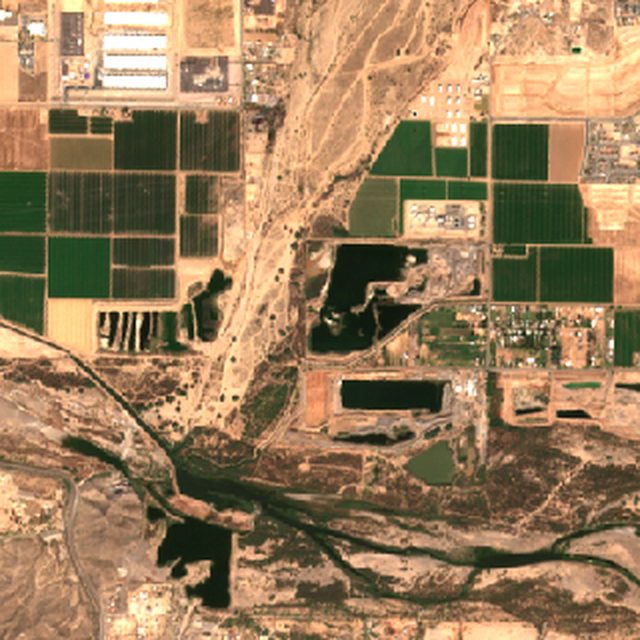

tsmc_az

tsmc - 16.0 km2 window - known fab cluster location (I-17 corridor, N Phoenix)
latest scenebaseline scene
baseline 2024-10-28latest 2026-10-08
SCENEBUILTAREAMETHOD
2024-10-280.9%0.14 km2P*
2026-10-081.3%0.21 km2P*

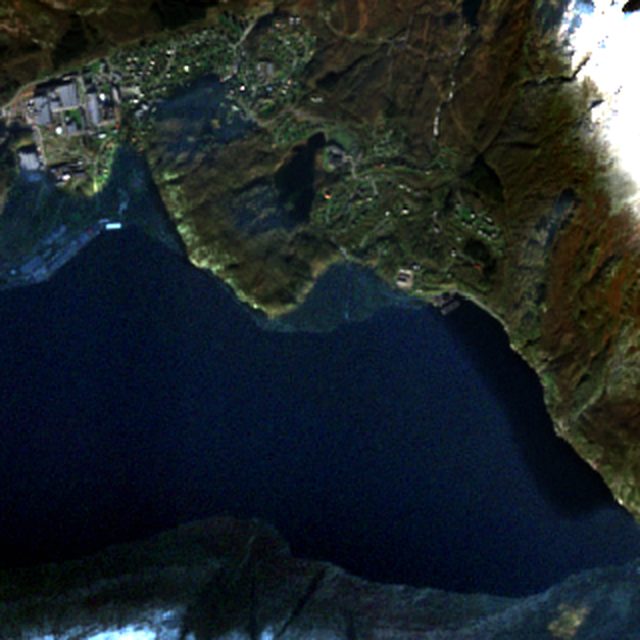

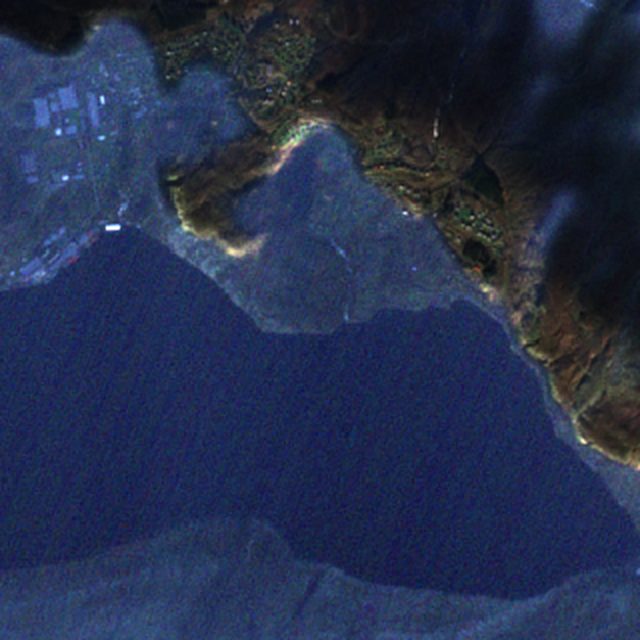

nscale_glomfjord

nscale with anthropic - 9.0 km2 window - Glomfjord industrial park (village location; PIN from facility records)
latest scenebaseline scene
baseline 2024-10-21latest 2026-10-09
SCENEBUILTAREAMETHOD
2024-10-211.9%0.17 km2P
2026-10-092.1%0.19 km2P

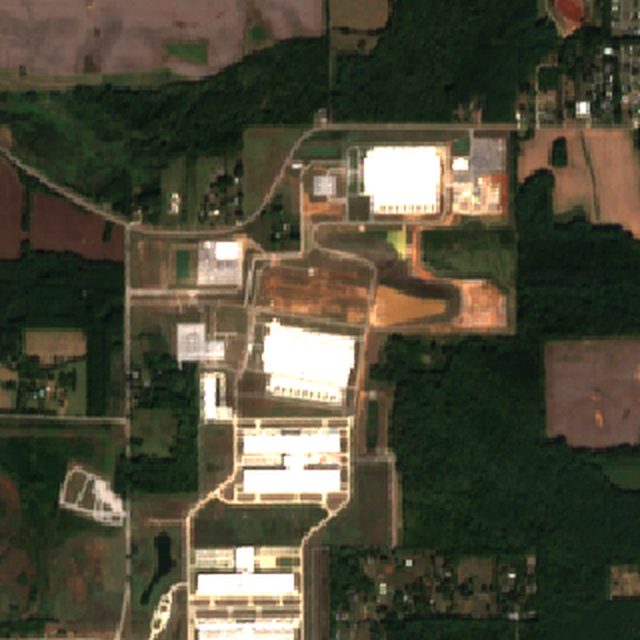

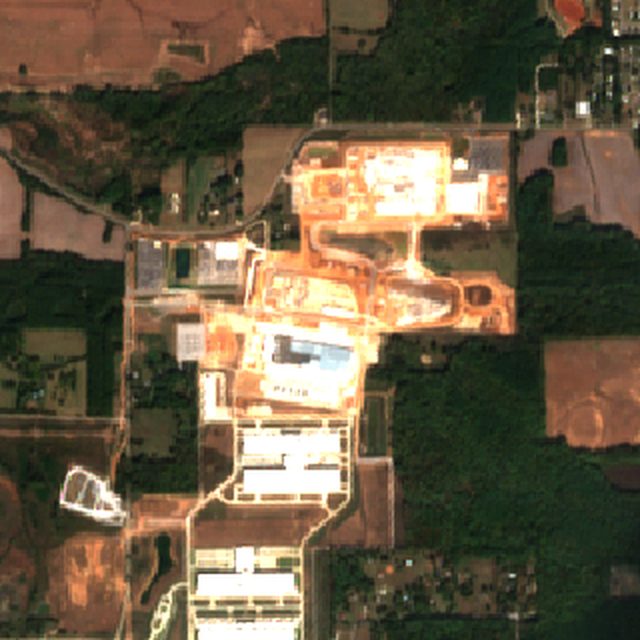

epoch_meta_huntsville

meta - 6.2 km2 window - Epoch map building polygons (n=65 vertices)
latest scenebaseline scene
baseline 2024-10-23latest 2026-10-13
SCENEBUILTAREAMETHOD
2024-10-234.3%0.27 km2P*
2026-10-134.1%0.26 km2P*

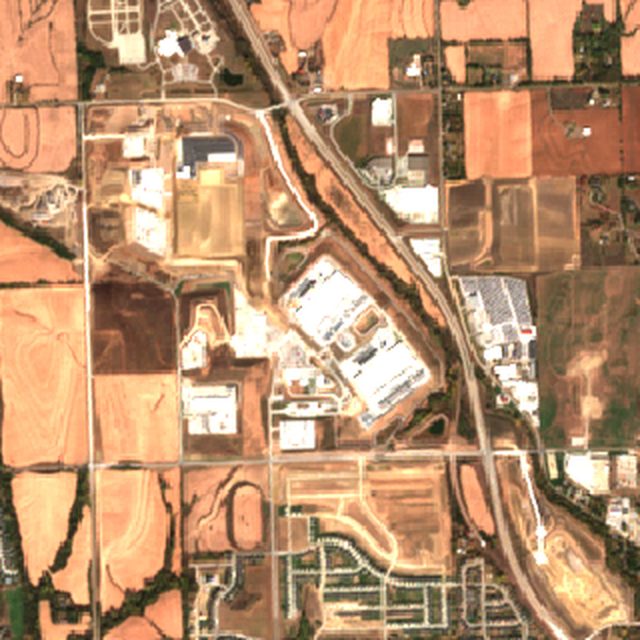

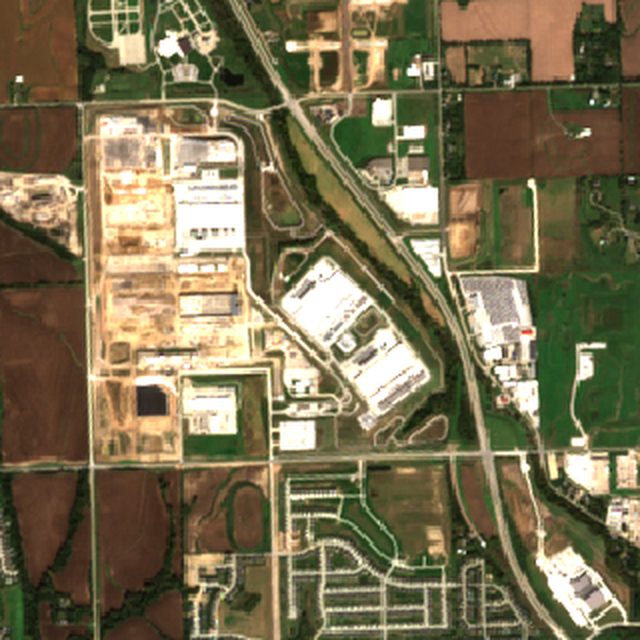

epoch_google_omaha

google - 7.5 km2 window - Epoch map building polygons (n=84 vertices)
latest scenebaseline scene
baseline 2024-10-25latest 2026-10-10
SCENEBUILTAREAMETHOD
2024-10-254.4%0.33 km2P*
2026-10-104.6%0.35 km2P*

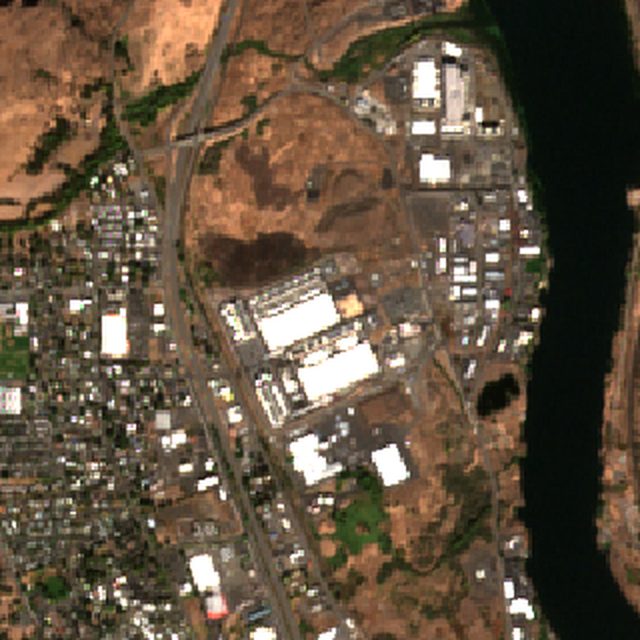

epoch_google_the_dalles

google - 5.0 km2 window - Epoch map building polygons (n=52 vertices)
latest scenebaseline scene
baseline 2024-10-13latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-134.9%0.25 km2P*
2026-10-154.8%0.24 km2P*

lc36_blue_origin

blue_origin - 9.0 km2 window - Cape Canaveral LC-36 (known pad location)
latest scenebaseline scene
baseline 2024-10-31latest 2026-10-14
SCENEBUILTAREAMETHOD
2024-10-314.3%0.39 km2P*
2026-10-144.3%0.39 km2P*

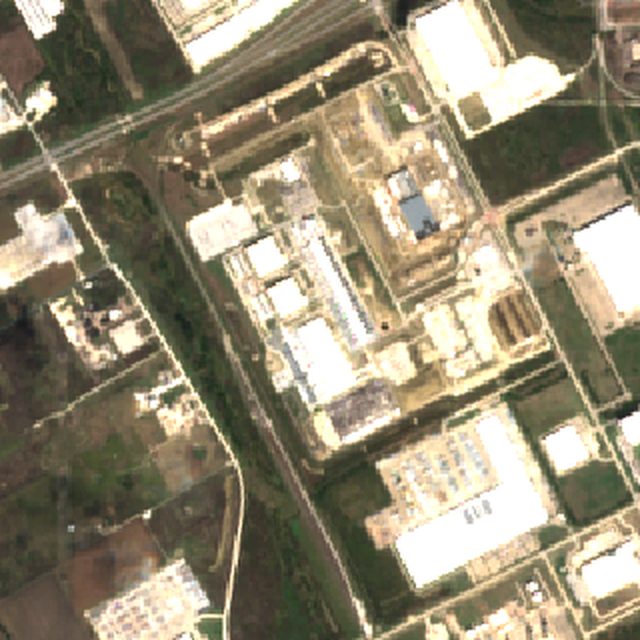

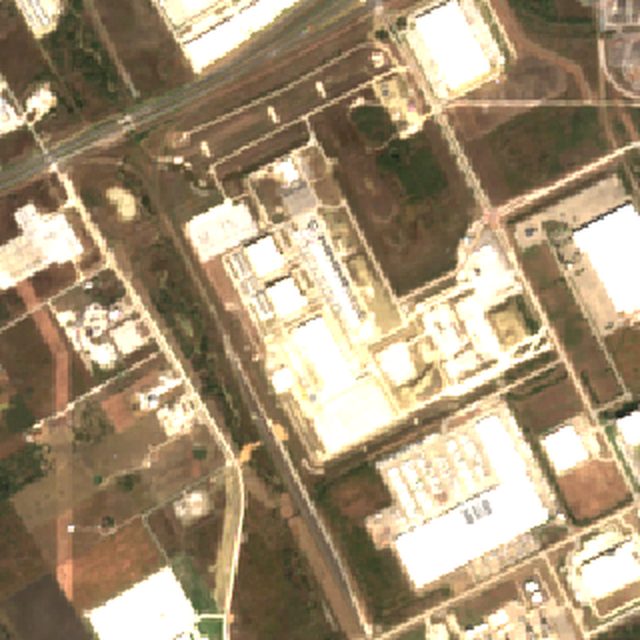

epoch_google_midlothian

google - 5.7 km2 window - Epoch map building polygons (n=42 vertices)
latest scenebaseline scene
baseline 2024-10-27latest 2026-10-15
SCENEBUILTAREAMETHOD
2024-10-2711.8%0.67 km2P*
2026-10-1511.8%0.67 km2P*

nscale_keflavik

nscale - 4.0 km2 window - Epoch building polygons (Valhallarbraut 868)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

micron_clay_ny

micron - 36.0 km2 window - APPROX Clay NY (White Pine Commerce Park)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

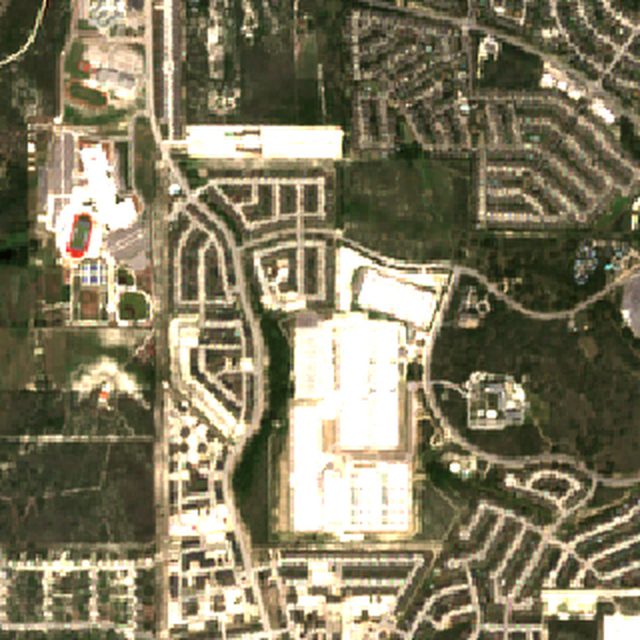

epoch_microsoft_sat40

microsoft with openai - 6.2 km2 window - Epoch map building polygons (n=61 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

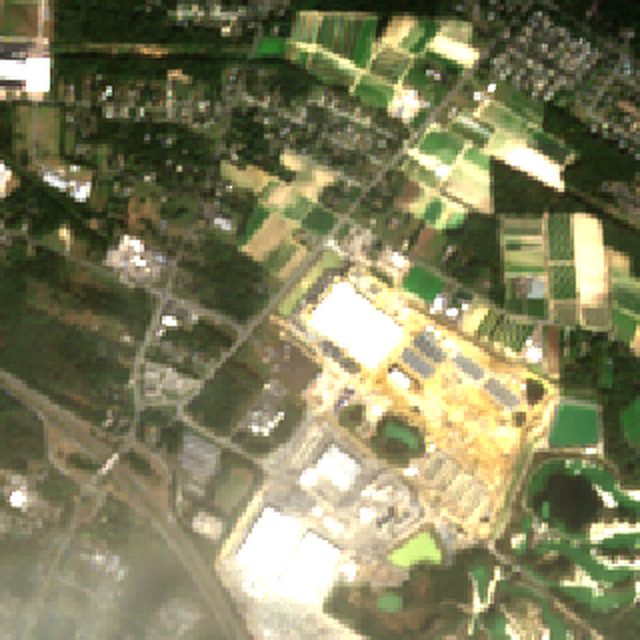

epoch_microsoft_nebius_new_jersey

microsoft with openai - 4.0 km2 window - Epoch map building polygons (n=41 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_microsoft_narvik_norway

microsoft with openai - 22.3 km2 window - Epoch map building polygons (n=50 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_microsoft_fairwater_atlanta

microsoft with openai - 12.7 km2 window - Epoch map building polygons (n=124 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_meta_los_lunas

meta - 8.1 km2 window - Epoch map building polygons (n=40 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_meta_eagle_mountain

meta - 7.8 km2 window - Epoch map building polygons (n=65 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_google_waltham_cross

google - 4.2 km2 window - Epoch map building polygons (n=28 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

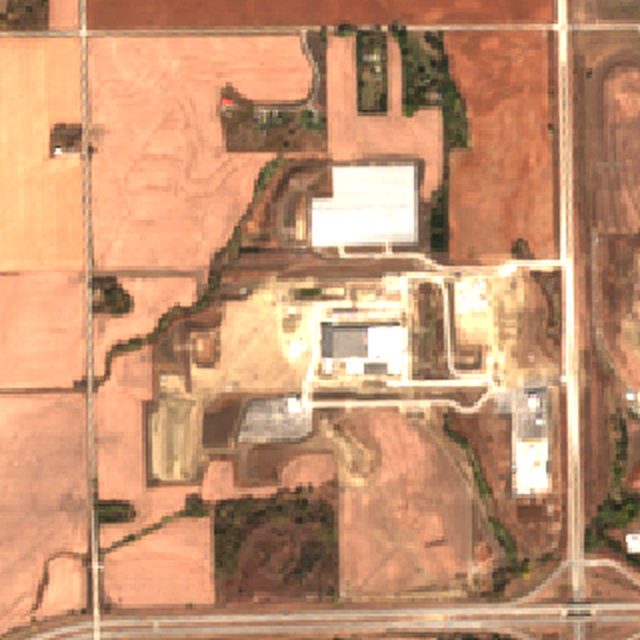

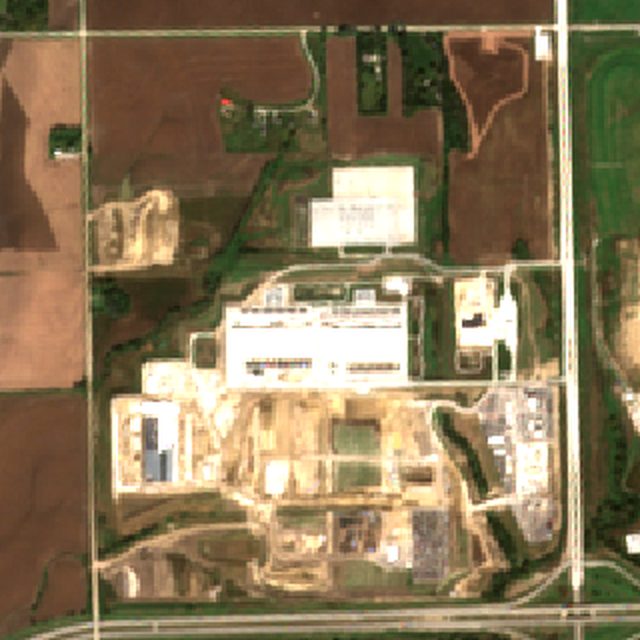

epoch_google_lincoln

google - 4.4 km2 window - Epoch map building polygons (n=45 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_google_lancaster

google - 4.3 km2 window - Epoch map building polygons (n=48 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

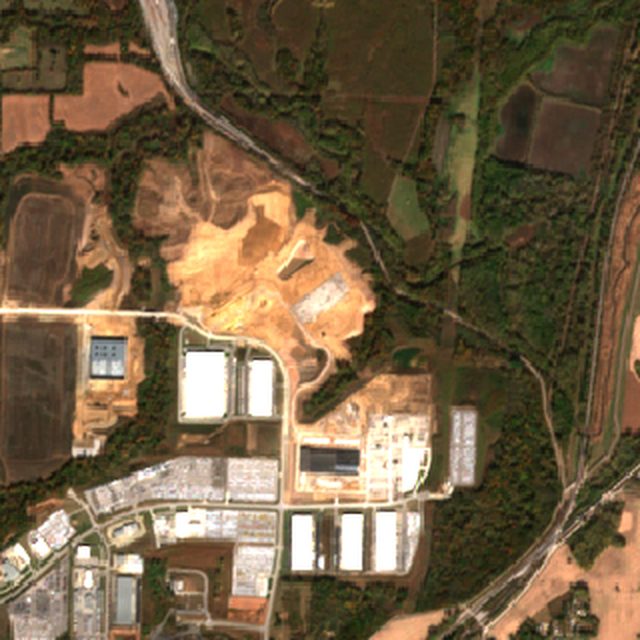

epoch_google_kansas_city_east

google - 8.2 km2 window - Epoch map building polygons (n=65 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_google_fort_wayne

google - 7.4 km2 window - Epoch map building polygons (n=55 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_google_bristow

google - 5.6 km2 window - Epoch map building polygons (n=74 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

epoch_coreweave_marble_nc

coreweave - 4.3 km2 window - Epoch map building polygons (n=34 vertices)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

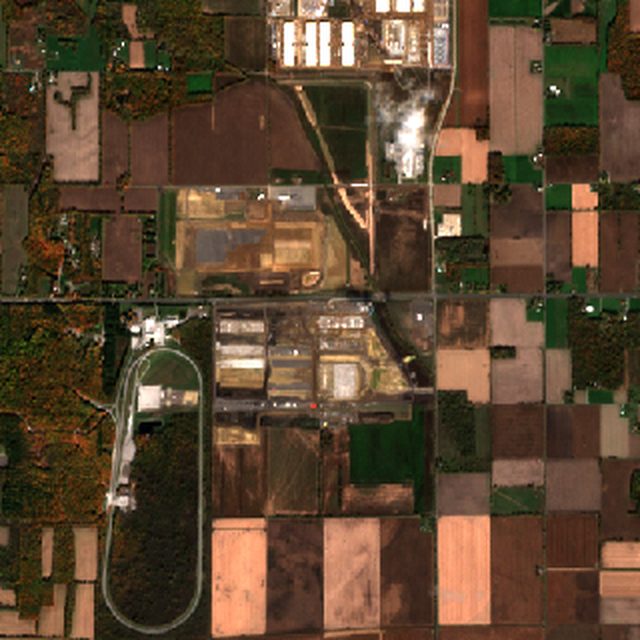

epoch_anthropic_amazon_new_carlisle

amazon with anthropic - 21.3 km2 window - Epoch map building polygons (n=195 vertices)
latest scenebaseline scene
no confirmed observations yet - the monthly Sentinel-2 pass fills this card

dayone_kempas

dayone - 16.0 km2 window - Epoch building polygons (Johor)
imagery lands with the next sat_watch run
no confirmed observations yet - the monthly Sentinel-2 pass fills this card
